Tag: National Cathedral

  • Forensic audit of National Cathedral by PwC almost complete – A-G

    Forensic audit of National Cathedral by PwC almost complete – A-G

    An international auditing firm, PricewaterhouseCoopers (PwC), which was tasked with the financial probe into the National Cathedral, will make its findings public in the coming days.

    Engaging the public at the Government Accountability Series forum on Monday, December 22, Dr. Dominic Ayine noted that PwC was engaged following consultations by President John Dramani Mahama with the Attorney-General, the Auditor-General, and the Minister for Finance.

    “After we met, and subsequently held discussions at the Ministry of Finance, it was decided that we should speedily engage a private audit firm to conduct the forensic audit,” he stated.

    According to him, the Attorney-General’s office is mandated to procure services related only to legal matters, and since the forensic audit of the National Cathedral is considered a non-legal service, it did not interfere in the process.

    “I cannot procure a forensic audit. Usually, if I am procuring services, they will be legal services, and there is no precedent of an Attorney-General procuring non-legal services. The last time I checked, they wrote to my office, this was last week, requesting a meeting with me to understand some issues that are germane to the audit work. They have done significant work and are getting to the end of their work,” he said.

    Earlier this year, President John Dramani Mahama tasked the audit firm Deloitte Touche with conducting an independent audit of the National Cathedral project.

    The report, which covered activities from December 2021 to December 2023, accused the Secretariat of procurement breaches, unsupported expenditures, and governance lapses.

    During a press briefing on Friday, July 18, Felix Kwakye Ofosu disclosed that the Secretariat spent 18,500 Ghana cedis on the expenses of one Kharis Psalmist; however, it failed to document the full cost rendered in its records.

    “A key example involves academic payment for Mr Kharis Psalmist who was lodged at the Movenpick Hotel from 16th to 28th February 2022 at a cost of 18,500 Ghana cedis. However, only 4,976.00 Ghana Cedis was recorded in the books with no documentation accounting for the remaining 13,524.00 Ghana Cedis, which reportedly a refund issued by the hotel but not traceable in the financial records,” he stated.

    As a result, the Attorney-General (AG) was instructed by President John Dramani Mahama to ensure all legal processes are initiated for the revocation of the board’s mandate.

    “The National Cathedral Ghana was registered limited by guarantee. In view of that, the Attorney General has been directed to take legal steps… and we expect that to be done in the coming days.”

    The report further explained that, contrary to the $58 million claimed by the former NPP government spent on the National Cathedral project, an outstanding $39 million owed to the contractor brings the total cost to $97 million. But the Executive Director of the National Cathedral Secretariat, Dr. Paul Opoku-Mensah, branded the report as false and incomplete.

    “While the government press conference made reference to audit findings, what was presented was not the actual audit report but rather audit queries that had been responded to in detail. This audit report does not exonerate anyone. However, it confirms that there has been no misuse of state funds. All payments made were supported by contracts and guided by legal and financial protocols,” the memo noted.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022. CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government, in April this year, dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

    Meanwhile, the government has revealed its plans to repurpose the stalled National Cathedral project into a National Cultural Convention Centre (NCCC) to become a central hub for Ghana’s creative economy and cultural diplomacy.

    Under the new “SH0W24” plan, part of the 24-hour economy for the creative sector, the NCCC will be developed with support from the African Continental Free Trade Area (AfCFTA) Secretariat and host exhibitions, film festivals, trade expos, and major summits.

    The project, the government notes, offers a smart solution to infrastructure challenges without clashing with religious or national values.

    “At the national level, a bold flagship intervention is proposed: converting the National Cathedral site into the National Cultural Convention Centre (NCCC), in partnership with the AfCFTA Secretariat. This venue will serve as Africa’s premier cultural diplomacy and creative economy forum, hosting international exhibitions, film festivals, trade shows, and summits—filling a critical infrastructure gap without conflicting with national values or faith institutions,” the document stated.

    The National Cultural Convention Centre (NCCC) is a key component of a wider strategy to revitalise Ghana’s creative arts, culture, and tourism sectors as major drivers of economic transformation.

    Its development marks a major policy shift regarding the use of the contested National Cathedral site, which has faced public criticism due to delays, rising costs, and questions about its necessity.

    Under the SH0W24 initiative, the NCCC is expected to become the flagship infrastructure project for the creative economy, with the capacity to host global exhibitions, festivals, and large-scale cultural events.

    The first phase of SH0W24 (2025–2026) will focus on feasibility studies, while the centre is expected to be fully operational in Phase 3 (2028–2030). Phase 2 will see the rollout of the Ghana Cultural Passport, regional programmes, and creative districts aimed at energising local economies. Phase 3 will take things further, focusing on exports and cross-border cultural partnerships.

    In addition, the SH0W24 strategy includes the creation of a National Creators Academy, which will train young people in fields such as music, film, fashion, digital media, and cultural performance, using modern tools like AI and virtual reality, along with business and cultural education.

  • Audit findings by Deloitte false and incomplete –  National Cathedral Secretariat fires back

    Audit findings by Deloitte false and incomplete – National Cathedral Secretariat fires back

    The National Cathedral Secretariat has responded to a recent report by an audit firm, Deloitte Touche, revealing the misappropriation of funds within its operations.

    According to an internal memo to staff dated July 21, Executive Director of the Secretariat, Dr. Paul Opoku-Mensah, branded the report as false and incomplete.

    “While the government press conference made reference to audit findings, what was presented was not the actual audit report but rather audit queries that had been responded to in detail.

    “This audit report does not exonerate anyone. However, it confirms that there has been no misuse of state funds. All payments made were supported by contracts and guided by legal and financial protocols,” the memo noted.

    Deloitte Touche was tasked by President John Dramani Mahama earlier this year to conduct an independent audit on the National Cathedral project.

    The report, which covered activities from December 2021 and December 2023, accused the Secretariat of procurement breaches, unsupported expenditures, and governance lapses.

    During a press briefing on Friday, July 18, Felix Kwakye Ofosu disclosed that the Secretariat spent 18,500 Ghana cedis on the expenses of one Kharis Psalmist; however, it failed to document the full cost rendered in its records.

    “A key example involves academic payment for Mr Kharis Psalmist who was lodged at the Movenpick Hotel from 16th to 28th February 2022 at a cost of 18,500 Ghana cedis.

    “However, only 4,976.00 Ghana Cedis was recorded in the books with no documentation accounting for the remaining 13,524.00 Ghana Cedis, which reportedly a refund issued by the hotel but not traceable in the financial records,” he stated.

    As a result, the Attorney General (AG) has been instructed by President John Dramani Mahama to ensure all legal processes are initiated for the revocation of the board’s mandate.

    “The National Cathedral Ghana was registered limited by guarantee. In view of that, the Attorney General has been directed to take legal steps… and we expect that to be done in the coming days.

    The report further explained that, contrary to the $58 million claimed by the former NPP government spent on the National Cathedral project, an outstanding $39 million owed to the contractor brings the total cost to $97 million.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government, in April this year, dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

    Meanwhile, the government has revealed its plans to repurpose the stalled National Cathedral project into a National Cultural Convention Centre (NCCC) to become a central hub for Ghana’s creative economy and cultural diplomacy.

    Under the new “SH0W24” plan, part of the 24-hour economy for the creative sector, the NCCC will be developed with support from the African Continental Free Trade Area (AfCFTA) Secretariat and host exhibitions, film festivals, trade expos, and major summits.

    The project, the government notes, offers a smart solution to infrastructure challenges without clashing with religious or national values.

    “At the national level, a bold flagship intervention is proposed: converting the National Cathedral site into the National Cultural Convention Centre (NCCC), in partnership with the AfCFTA Secretariat. This venue will serve as Africa’s premier cultural diplomacy and creative economy forum, hosting international exhibitions, film festivals, trade shows, and summits-filling a critical infrastructure gap without conflicting with national values or faith institutions,” the document stated.

    The National Cultural Convention Centre (NCCC) is a key component of a wider strategy to revitalise Ghana’s creative arts, culture, and tourism sectors as major drivers of economic transformation.

    Its development marks a major policy shift regarding the use of the contested National Cathedral site, which has faced public criticism due to delays, rising costs, and questions about its necessity.

    Under the SH0W24 initiative, the NCCC is expected to become the flagship infrastructure project for the creative economy, with the capacity to host global exhibitions, festivals, and large-scale cultural events.

    The first phase of SH0W24 (2025–2026) will focus on feasibility studies, while the centre is expected to be fully operational in Phase 3 (2028–2030). Phase 2 will see the rollout of the Ghana Cultural Passport, regional programmes, and creative districts aimed at energising local economies. Phase 3 will take things further, focusing on exports and cross-border cultural partnerships.

    In addition, the SH0W24 strategy includes the creation of a National Creators Academy, which will train young people in fields such as music, film, fashion, digital media, and cultural performance, using modern tools like AI and virtual reality, along with business and cultural education.

  • National Cathedral Board of Trustees to be dissolved – Felix Kwakye

    National Cathedral Board of Trustees to be dissolved – Felix Kwakye

    The Board of Trustees of the National Cathedral of Ghana is expected to be dissolved in the coming days.

    This was made known by the Government Spokesperson, Felix Kwakye Ofosu, during a press briefing on Friday, July 18.

    According to him, the Attorney General (AG) has been instructed by President John Dramani Mahama to ensure all legal processes are initiated for the revocation of the board’s mandate.

    The decision to dissolve the board was prompted by a recent audit report from Deloitte and Touche on the National project.

    “The above audit findings rock the very foundation of the project and the work of the Secretariat and raise serious questions about the use of public funds.

    “The National Cathedral Ghana was registered limited by guarantee. In view of that, the Attorney General has been directed to take legal steps… and we expect that to be done in the coming days.

    “The audit report for the 2022 financial year uncovers a troubling pattern of poor accounting practices, unsupported expenditures and lapses in financial oversight at the National Cathedral Secretariat, ” he revealed.

    He added that the Secretariat spent 18,500 Ghana cedis on the expenses of one Kharis Psalmist; however, it failed to document the full cost rendered in its records.

    “A key example involves academic payment for Mr Kharis Psalmist who was lodged at the Movenpick Hotel from 16th to 28th February 2022 at a cost of 18,500 Ghana cedis.

    “However, only 4,976.00 Ghana Cedis was recorded in the books with no documentation accounting for the remaining 13,524.00 Ghana Cedis, which reportedly a refund issued by the hotel but not traceable in the financial records,” he stated.

    The report further explained that, contrary to the $58 million claimed by the former NPP government spent on the National Cathedral project, an outstanding $39 million owed to the contractor brings the total cost to $97 million.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government, in April this year, dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

    Read full Deloitte audit report below:

  • Deloitte’s full audit report on National Cathedral project

    Deloitte’s full audit report on National Cathedral project

    The National Cathedral project, initiated under the previous Akufo-Addo government, has sparked recent debate, following a report by an audit firm Deloitte and Touche.

    The firm was tasked by President John Dramani Mahama earlier this year to conduct an independent audit on the National Cathedral project.

    According to the report, the country incurred $97 million loss on the National Cathedral project.

    The report explained that, contrary to the $58 million claimed by the former NPP government, an outstanding $39 million owed to the contractor brings the total cost to $97 million.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government, in April this year, dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

    Read full Deloitte audit report below:

  • Ghana has lost $97m to stalled National Cathedral project – Felix Ofosu

    Ghana has lost $97m to stalled National Cathedral project – Felix Ofosu

    A new revelation has emerged regarding the amount of funds allocated to the National Cathedral project, initiated under the previous Akufo-Addo government.

    Addressing journalists on Friday, July 18, the Minister of Government Communication, Felix Kwakye Ofosu, disclosed that Ghana has lost $97 million to the National Cathedral project.

    He explained that, contrary to the $58 million claimed by the former NPP government, an outstanding $39 million owed to the contractor brings the total cost to $97 million.

    According to him, the new cost was made known in a report submitted by Deloitte and Touche after its audit on the project.

    “Equally troubling is the failure of management to produce documents to support several transactions, including office costs, board expenses, and accommodation for the symposium hosted by the Biblical Museum of Africa.”

    “It bears noting that documentation available indicates that contrary to the widely held view that total payments and commitments to the National Cathedral Project amount to $58 million so far, there is an additional outstanding $39 million payment due the contractor. This will bring the total cost incurred for the hole at the site of the project to $97 million,” he disclosed.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government in April this year dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

  • Was there no consultation before deciding to discontinue National Cathedral project? – Koku Anyidoho quizzes

    Was there no consultation before deciding to discontinue National Cathedral project? – Koku Anyidoho quizzes

    Former Deputy General Secretary of the National Democratic Congress (NDC), Samuel Koku Anyidoho, has suggested there was lack of consultation in the decision to convert the National Cathedral project to the National Cultural Convention Center.

    Taking to the X platform on Wednesday, July 8, he reacted to the board of directors of the National Cathedral’s justification for the completion of the project.

    “National Cathedral Board resists any attempt to convert project into National Cultural Convention Center. So no consultation was done before decision taken by Government? Hmmm!!!,” he wrote.

    The Board had proposed that the government complete the project to host Ghanaians, so it can be used to host Ghanaians during the National Day of Prayer.

    The recommendation comes from the government’s intention to turn the NCCC into a central hub for Ghana’s creative economy and cultural diplomacy.

    However, the Board has further noted that the integration of additional elements including a Bible Museum that tells the history and contributions of the church in Ghana and Africa, including the Ghanaian and African Diaspora, ensures the Cathedral is also developed as a heritage and cultural site that promotes religious pilgrimage and international tourism.

    The Board noted that the designs for the Cathedral, the Bible Museum, Biblical Garden, Economic Engine-comprising 10 revenue streams including a 350-seater restaurant, banquet hall, conference hall, library, have all been completed based on the layout and specifications of the site.

    “Preparatory works on the land have all been completed, and with the architectural and design work for the Cathedral and Bible Museum also completed, actual construction of the National Cathedral began in 2021, with eight percent (8%) of construction done,” the Board further added.

    It noted that the project has not been abandoned despite its suspension due to lack of funds caused by politicisation and vilification of the project.

    Under the new “SH0W24” plan, part of the 24-hour economy for the creative sector, the NCCC will be developed with support from the African Continental Free Trade Area (AfCFTA) Secretariat and host exhibitions, film festivals, trade expos, and major summits.

    The project, the government notes, offers a smart solution to infrastructure challenges without clashing with religious or national values.

    “At the national level, a bold flagship intervention is proposed: converting the National Cathedral site into the National Cultural Convention Centre (NCCC), in partnership with the AfCFTA Secretariat. This venue will serve as Africa’s premier cultural diplomacy and creative economy forum, hosting international exhibitions, film festivals, trade shows, and summits-filling a critical infrastructure gap without conflicting with national values or faith institutions,” the document stated.

    The National Cultural Convention Centre (NCCC) is a key component of a wider strategy to revitalise Ghana’s creative arts, culture, and tourism sectors as major drivers of economic transformation.

    Its development marks a major policy shift regarding the use of the contested National Cathedral site, which has faced public criticism due to delays, rising costs, and questions about its necessity.

    Under the SH0W24 initiative, the NCCC is expected to become the flagship infrastructure project for the creative economy, with the capacity to host global exhibitions, festivals, and large-scale cultural events.

    The first phase of SH0W24 (2025–2026) will focus on feasibility studies, while the centre is expected to be fully operational in Phase 3 (2028–2030). Phase 2 will see the rollout of the Ghana Cultural Passport, regional programmes, and creative districts aimed at energising local economies. Phase 3 will take things further, focusing on exports and cross-border cultural partnerships.

    In addition, the SH0W24 strategy includes the creation of a National Creators Academy, which will train young people in fields such as music, film, fashion, digital media, and cultural performance, using modern tools like AI and virtual reality, along with business and cultural education.

    The government plans to build or upgrade more than 250 community centres across the country as part of the 24H+ Community Centre Network. These centres will stay open all day and night, offering space for training, creative work, exhibitions, and performances to support local arts and boost nighttime business.

    To help local artists reach more people, a new digital platform called the Ghana Cultural Passport will be introduced. It will showcase cultural experiences to tourists, especially those from the diaspora. Ghana’s embassies will help promote creative exports, and artists will get licensing and export support to reach international markets.

    To keep creative businesses running, the plan includes financial support through two funds: the 24H+ Value Chain Financing Facility and a Technical Assistance Grant Facility.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government in April this year dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

  • Stalled National Cathedral to be converted into National Cultural Convention Centre

    Stalled National Cathedral to be converted into National Cultural Convention Centre

    Government has revealed plans to repurpose the stalled National Cathedral project into a National Cultural Convention Centre (NCCC) to become a central hub for Ghana’s creative economy and cultural diplomacy.

    Under the new “SH0W24” plan, part of the 24-hour economy for the creative sector, the NCCC will be developed with support from the African Continental Free Trade Area (AfCFTA) Secretariat and host exhibitions, film festivals, trade expos, and major summits.

    The project, the government notes, offers a smart solution to infrastructure challenges without clashing with religious or national values.

    “At the national level, a bold flagship intervention is proposed: converting the National Cathedral site into the National Cultural Convention Centre (NCCC), in partnership with the AfCFTA Secretariat. This venue will serve as Africa’s premier cultural diplomacy and creative economy forum, hosting international exhibitions, film festivals, trade shows, and summits-filling a critical infrastructure gap without conflicting with national values or faith institutions,” the document stated.

    The National Cultural Convention Centre (NCCC) is a key component of a wider strategy to revitalise Ghana’s creative arts, culture, and tourism sectors as major drivers of economic transformation.

    Its development marks a major policy shift regarding the use of the contested National Cathedral site, which has faced public criticism due to delays, rising costs, and questions about its necessity.

    Under the SH0W24 initiative, the NCCC is expected to become the flagship infrastructure project for the creative economy, with the capacity to host global exhibitions, festivals, and large-scale cultural events.

    The first phase of SH0W24 (2025–2026) will focus on feasibility studies, while the centre is expected to be fully operational in Phase 3 (2028–2030). Phase 2 will see the rollout of the Ghana Cultural Passport, regional programmes, and creative districts aimed at energising local economies. Phase 3 will take things further, focusing on exports and cross-border cultural partnerships.

    In addition, the SH0W24 strategy includes the creation of a National Creators Academy, which will train young people in fields such as music, film, fashion, digital media, and cultural performance, using modern tools like AI and virtual reality, along with business and cultural education.

    The government plans to build or upgrade more than 250 community centres across the country as part of the 24H+ Community Centre Network. These centres will stay open all day and night, offering space for training, creative work, exhibitions, and performances to support local arts and boost nighttime business.

    To help local artists reach more people, a new digital platform called the Ghana Cultural Passport will be introduced. It will showcase cultural experiences to tourists, especially those from the diaspora. Ghana’s embassies will help promote creative exports, and artists will get licensing and export support to reach international markets.

    To keep creative businesses running, the plan includes financial support through two funds: the 24H+ Value Chain Financing Facility and a Technical Assistance Grant Facility.

    The National Cathedral, originally proposed under the administration of former President Nana Addo Dankwa Akufo-Addo, was envisioned as a monumental Christian worship centre in Ghana.

    But the project progressed at a snail’s pace, spiralling costs and the use of public funds in a secular state. According to reports, a total amount of $58 million was spent on the project deemed to be Ghana’s most expensive bit.

    Over a year ago, Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, raised concerns with the Commission on Human Rights and Administrative Justice (CHRAJ), alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    After investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    The Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022.

    CHRAJ’s detailed report recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    The government in April this year dissolved the National Cathedral Secretariat after noting that it would no longer provide funding for the abandoned project.

  • CenPOA urges Akufo-Addo to accumulate funds privately to complete National Cathedral

    CenPOA urges Akufo-Addo to accumulate funds privately to complete National Cathedral

    The Centre for Public Opinion and Awareness (CenPOA), a non-partisan civil organization, has called on former President Nana Addo Dankwa Akufo-Addo to take the lead in privately raising funds to complete the National Cathedral project.

    In a statement released on April 9, 2025, CenPOA emphasized that the former president’s commitment to the project should not waver simply because his tenure has ended.

    The group encouraged him to use his influence and connections to fulfill his vision without relying on public funds.

    “We encourage former President Akufo-Addo to fulfill his vow to God using private means. With his tenure now concluded, he has the opportunity and time to mobilize private support to complete the project, in line with his original intent,” the statement read.

    CenPOA’s appeal follows recent remarks by Ahmed Ibrahim, the Minister for Chieftaincy and Religious Affairs, regarding the stalled National Cathedral project.

    The organization warned that any attempt by the current government to revive the project using public funds would be seen as a betrayal of public trust and a breach of political integrity.

    The group also highlighted the importance of respecting the wishes of Ghanaians, urging the government to avoid burdening taxpayers with the cost of the project.

    CenPOA’s statement underscores the need for private initiative and accountability in completing the National Cathedral.

    Read statement below:

    CenPOA to Government: Proceed with National Cathedral Project at Your Own Risk

    The Center for Public Opinion & Awareness (CenPOA) has noted with deep concern recent comments made by Honorable Ahmed Ibrahim, Minister for Local Government, Chieftaincy and Religious Affairs, regarding the possible continuation of the controversial National Cathedral project.

    Hon. Ibrahim indicated that the government is considering resuming the project, subject to consultations he is currently undertaking with the National Cathedral Board.

    CenPOA strongly believes that any attempt to reintroduce government involvement or allocate public funds to the National Cathedral would constitute political dishonesty and a serious betrayal of the trust placed in the government by Ghanaians.

    The National Cathedral was originally a personal religious vow made by former President Nana Akufo-Addo, who, despite serving a full eight-year term, was unable to complete it—after reportedly spending $58 million of state resources.

    It is worth noting that the project became a major point of political contention during the 2024 elections.

    The now-ruling National Democratic Congress (NDC) explicitly opposed the project, vowing to repurpose it into a 500-unit children’s hospital and fertility center. This was publicly communicated in a Facebook post by Dr. Edward Omane Boamah, then Director of Elections and IT for the NDC.

    In light of this, CenPOA finds the Minister’s recent remarks inconsistent with the NDC’s stated position and urges the government to stay true to its commitment to reset Ghana’s priorities. Many Ghanaians voted for this administration on the understanding that public funds would no longer be wasted on nonessential projects like the National Cathedral, particularly at the expense of critical sectors such as healthcare, education, and job creation.

    If Hon. Ibrahim’s remarks were intended as his personal opinion, we wish to respectfully remind him that, in his capacity as a Minister, he must refrain from imposing personal religious beliefs on matters of governance and public administration. Blurring the lines between religion and state affairs could have serious consequences for his political career and the credibility of the NDC government.

    Finally, we encourage former President Akufo-Addo to fulfill his vow to God using private means. With his tenure now concluded, he has the opportunity and time to mobilize private support to complete the project, in line with his original intent.

  • National Cathedral Secretariat dissolved by govt

    National Cathedral Secretariat dissolved by govt

    The National Cathedral Secretariat, a project initiated by former President Nana Akufo-Addo as a national Christian worship center and a symbol of Ghana’s religious heritage, has been dissolved by the government.

    The dissolution marks a major shift in the government’s stance on the controversial project, which faced widespread criticism over allegations of financial mismanagement, stalled construction, and questions over its funding transparency.

    Speaking on Channel One, Felix Kwakye Ofosu, the Minister of State in Charge of Government Communications, confirmed that the government would no longer provide funding for the abandoned project.

    He emphasized that the decision reflects President John Dramani Mahama’s consistent position that taxpayer money should not be used to finance the National Cathedral.

    “There are outstanding issues regarding the procurement processes, and outstanding payments that the contractor is demanding, but nobody will answer because there is no National Cathedral,” Mr. Kwakye Ofosu stated.

    Commission on Human Rights and Administrative Justice (CHRAJ) has urged the Auditor-General to launch a forensic audit into the controversial National Cathedral project.

    This recommendation stems from CHRAJ’s findings after a complaint filed by North Tongu MP, Samuel Okudzeto Ablakwa.

    Approximately a year ago, Mr. Ablakwa raised concerns with CHRAJ, alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    He also questioned the transfer of GH₵2.6 million from the Secretariat to JNS Talent Centre Limited, a company involved in the construction.

    In the findings released by CHRAJ on Monday, November 25, after investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    “Accordingly, the Commission recommends that the Auditor-General should conduct a forensic audit of the construction of the National Cathedral project from its inception to date to ascertain whether monies released for its construction have been properly utilised,” CHRAJ noted.

    CHRAJ’s detailed report has recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    CHRAJ concluded that Mr. Ablakwa’s claims of breaches in mandatory procurement procedures were valid.

  • Akufo-Addo embarrassed to report on $58m National Cathedral fiasco – Ablakwa

    Akufo-Addo embarrassed to report on $58m National Cathedral fiasco – Ablakwa

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has criticized President Nana Addo Dankwa Akufo-Addo for failing to address the controversial National Cathedral project during his final State of the Nation Address (SONA).

    In a post on the X platform, Ablakwa condemned the President’s silence on the $58 million project, which the President had once described as his “priority of priorities.” He described the continued payment of high salaries to staff of the National Cathedral Secretariat as an affront to struggling Ghanaian taxpayers.

    “Recent payment records intercepted reveal that just four days ago, staff of the Secretariat received salaries ranging from GHS20,721 to GHS29,838 for December,” Ablakwa disclosed.

    He further noted that these payments continued despite a report by the Commission on Human Rights and Administrative Justice (CHRAJ) declaring the project illegal and calling for the prosecution of those involved. Ablakwa described the ongoing salary payments as a reckless financial loss to the state, emphasizing that the construction site had remained abandoned for 33 months.

    “The President may have avoided mentioning the National Cathedral during his address, but he should be even more embarrassed by the unjustified continuation of salary payments for a stalled project,” he added.

    Ablakwa expressed confidence that with the NPP’s defeat in the December elections, the payments would be halted by January 2025 and the Secretariat dissolved.

    Meanwhile, CHRAJ has called for a forensic audit into the project, citing financial irregularities and breaches of Ghana’s procurement laws.

    In a report dated November 22, 2024, the Commission highlighted that GHS225.9 million in “seed money” had been spent on activities including site preparation, contractor mobilization, and consultancy services as of May 31, 2022. CHRAJ stressed the need for public accountability, urging the Auditor-General to conduct a detailed review to ensure value for money.

    The investigation, prompted by a petition from Ablakwa, also revealed that the construction contract awarded to Ribade Company Ltd violated the Procurement Act, rendering it legally void. CHRAJ recommended that the Public Procurement Authority (PPA) cancel the contract and investigate the Board of Trustees for their involvement in the procurement breaches.

    “The PPA should intervene and cancel the contract between the National Cathedral and Ribade Company Ltd,” the report concluded.

  • We didn’t communicate transparently, properly  about the project – Miracles Aboagye on National Cathedral

    We didn’t communicate transparently, properly about the project – Miracles Aboagye on National Cathedral

    The future of the National Cathedral project remains unclear, even after the government has spent over GHC 339 million, with construction still at the foundation stage.

    Allegations of financial mismanagement and embezzlement have also surfaced, implicating individuals connected to the project.

    Initially, President Nana Akufo-Addo assured Ghanaians that the project would be funded through private sector contributions. However, it was later revealed that public funds were being used, sparking criticism and controversy.

    spokesperson for Vice President Dr. Mahamudu Bawumia’s campaign, Dennis Miracles Aboagye, addressed the issue during an interview on Joy News’ Newsfile program on December 14.

    He attributed the project’s setbacks to the government’s failure to communicate transparently about the use of state funds. According to Mr. Aboagye, the controversy could have been avoided if the government had been upfront from the beginning.

    “Communication around such things is very important. I’m sure that what the government, or the Finance Minister who I heard repeatedly promoting this project, should have communicated from the beginning is that, even though funds will be raised from private individuals and corporate organisations, we need to start.

    We need to demolish and prepare the site, and for that reason, the government will provide some seed money. But that is not going to be the funding to actually execute the project. If we had communicated this properly, we wouldn’t be where we are now,” he explained.

    He added, “I don’t think the communication was handled correctly, and when that happens, you allow your detractors to take advantage and lead the conversation.”

    The building of the Cathedral was in fulfilment of a supposed promise President Akufo-Addo claimed to have made to God before winning the 2016 elections.

    In 2019, the Finance Minister, Ken Ofori-Atta, stated that the construction of the National Cathedral was estimated to cost over $100 million.

    Amid the controversies surrounding the development, the Commission on Human Rights and Administrative Justice (CHRAJ), after investigating the case, recommended that the Auditor General conduct a forensic audit of the project to determine what went wrong and possibly prosecute those found to have committed any wrongdoing.

  • Akufo-Addo faces calls to refund $58m in stalled national cathedral project

    A recent report by Ghana’s Commission on Human Rights and Administrative Justice (CHRAJ) has reignited controversy over the National Cathedral project, with North Tongu MP Samuel Okudzeto Ablakwa demanding financial restitution from President Nana Addo Dankwa Akufo-Addo.

    The CHRAJ report highlights procurement breaches, alleged mismanagement of funds, and questions over public spending priorities amid economic challenges.

    The Commission revealed that approximately $312,394,049.53 has been spent on the halted project, including $58 million in what Ablakwa describes as “illegality.”

    CHRAJ found that the contract awarded to Ribade Company Limited, the project’s contractor, violated Ghana’s procurement laws, rendering it invalid. The report recommended the Public Procurement Authority (PPA) cancel the contract and urged a forensic audit of the project to determine the use of state funds.

    “Having found that the contract awarded to Ribade Company Ltd is void ab initio for being entered into contrary to the mandatory provisions of the Procurement Act, Act 663 as amended by Act 914, the Commission also recommends that the Board of the Public Procurement Authority (PPA) should intervene to cancel the contract for the construction of the National Cathedral between the National Cathedral and Ribade Company as it has the power to do so under the Procurement Act,” the Commission reported.

    Ablakwa criticised the President’s role, stating, “Everything begins and ends at the doorstep of Akufo-Addo,” and called for him to refund the $58 million. “President Akufo-Addo must be made to pay the compensation claims, refund $58 million, and cover the hole. The eminent clergymen were deceived by Akufo-Addo; everything begins and ends at the doorstep of Akufo-Addo,” he told the media in response to CHRAJ’s report on the matter.

    He also demanded the immediate dissolution of the National Cathedral Secretariat, questioning why board members continue to draw salaries despite the project being stalled for over 30 months.

    “The continuous payment for salary to the National Cathedral Board must stop. I don’t expect them to see their November salary. A project that has come to a halt for 38 months and the board is receiving a salary,” he added.

    CHRAJ’s findings followed a 2023 petition by Ablakwa, which highlighted concerns over payments made to JNS Talent Centre Limited and alleged conflicts of interest involving Rev. Victor Kusi-Boateng, a board member of the National Cathedral. The Commission substantiated claims of procurement irregularities but dismissed allegations of conflict of interest.

    The National Cathedral, a centrepiece of President Akufo-Addo’s 2016 campaign promises, has faced significant public opposition. Critics argue that taxpayer funds should not be used for its construction, especially given Ghana’s pressing economic issues, including a recent debt restructuring program.

    CHRAJ’s recommendations include prosecuting those responsible for procurement violations and conducting a comprehensive audit of all expenditures linked to the project.

    Ablakwa emphasised that accountability must be enforced, stating, “The $58 million must be refunded because we can’t spend taxpayers’ money on an illegality.”

  • Anyone who breached the law in spending of money for national cathedral must be dealt with – Domelevo

    Anyone who breached the law in spending of money for national cathedral must be dealt with – Domelevo

    Former Auditor-General Daniel Yao Domelevo has called for individuals to be held accountable if any legal breaches are uncovered in the use of funds allocated for the National Cathedral project.

    Speaking on Joy FM’s Newsnight on Monday, November 25, Mr. Domelevo endorsed a recommendation by the Commission on Human Rights and Administrative Justice (CHRAJ) for a forensic audit to determine whether funds disbursed for the project were appropriately utilized.

    Citing a Supreme Court ruling in Occupied Ghana vs Attorney General, Domelevo highlighted the Auditor-General’s obligation to disallow and surcharge expenditures that violate the law.

    He argued that if infractions are identified in the release or procurement processes for the funds, both the Ministry of Finance and the National Cathedral trustees must be held accountable.

    “If the Minister of Finance breached [the law], he may have to be held accountable. If he didn’t breach it but the procurement process was breached by the trustees, then, unfortunately, they are men of God, but public funds, they must be held accountable,” Domelevo stated.

    He stressed that all public funds, regardless of the recipients, are subject to strict legal scrutiny and accountability measures.

    Mr. Domelevo emphasized that spending from the consolidated fund must strictly adhere to Article 178 of the Constitution, which mandates parliamentary approval or authorization by law.

    “You cannot use the consolidated fund unless it is a charge on appropriation, by supplementary act, or an appropriation act. It must be approved by Parliament. Clause 2 says that even if it is not from the consolidated fund—that is, any other fund—it must be authorized by the Act which established that fund,” he explained.

    He added, “So we need to see that there is a law permitting the use of audit funds for the cathedral. Was it in an appropriate, a subsidiary that must be established beyond doubt.”

    This recommendation stems from a CHRAJ report following a petition by North Tongu MP Samuel Okudzeto Ablakwa.

    The MP had raised concerns about alleged discrepancies in the construction of the National Cathedral and questioned a transfer of GH₵2.6 million from the National Cathedral Secretariat to JNS Talent Centre Limited, a company involved in the project.

  • CHRAJ calls for a forensic audit of the National Cathedral project

    CHRAJ calls for a forensic audit of the National Cathedral project

    Commission on Human Rights and Administrative Justice (CHRAJ) has urged the Auditor-General to launch a forensic audit into the controversial National Cathedral project.

    This recommendation stems from CHRAJ’s findings after a complaint filed by North Tongu MP, Samuel Okudzeto Ablakwa.

    Approximately a year ago, Mr. Ablakwa raised concerns with CHRAJ, alleging irregularities in the project’s construction and the operations of the National Cathedral Secretariat.

    He also questioned the transfer of GH₵2.6 million from the Secretariat to JNS Talent Centre Limited, a company involved in the construction.

    In the findings released by CHRAJ on Monday, November 25, after investigating the case for several months, the Commission recommended that the Office of the Auditor-General intervene and conduct a forensic audit to ascertain whether funds allocated for the project were used for their intended purposes.

    “Accordingly, the Commission recommends that the Auditor-General should conduct a forensic audit of the construction of the National Cathedral project from its inception to date to ascertain whether monies released for its construction have been properly utilised,” CHRAJ noted.

    CHRAJ’s detailed report has recommended the potential prosecution of the board of trustees overseeing the National Cathedral project, citing their role in awarding the contract to Ribade Company Limited.

    The report highlighted multiple violations of procurement regulations and warned that the failure of those involved to address the issues could tarnish Ghana’s reputation both locally and internationally.

    CHRAJ concluded that Mr. Ablakwa’s claims of breaches in mandatory procurement procedures were valid.

    However, the Commission determined that allegations against Reverend Victor Kusi-Boateng, Secretary of the National Cathedral Board of Trustees, involving conflicts of interest and the use of multiple identities, lacked sufficient evidence to be substantiated.

  • Conduct a forensic audit of National Cathedral project – CHRAJ

    Conduct a forensic audit of National Cathedral project – CHRAJ

    The Commission on Human Rights and Administrative Justice (CHRAJ) has called for a forensic audit into the National Cathedral project, citing concerns over financial irregularities and breaches of Ghana’s procurement laws.

    In its report dated November 22, 2024, CHRAJ highlighted the need for a comprehensive review of the GHS225,962,500.00 spent as “seed money” on activities such as site preparation, contractor mobilization, fundraising, consultancy services, and symposia as of May 31, 2022. The Commission emphasized that public interest demands transparency and accountability to ensure value for money on the controversial project, which remains incomplete.

    “The Auditor-General should conduct a forensic audit of the National Cathedral project to ascertain value for money,” the report stated.

    The investigation, triggered by a petition from North Tongu MP Samuel Okudzeto Ablakwa, also revealed that the construction contract awarded to Ribade Company Ltd violated provisions of the Procurement Act, rendering it “void ab initio.” CHRAJ has recommended that the Public Procurement Authority (PPA) cancel the contract and investigate the Board of Trustees for their role in the procurement breaches.

    “The Board of the Public Procurement Authority should intervene to cancel the contract for the construction of the National Cathedral between the National Cathedral and Ribade Company Ltd,” the report added.

    CHRAJ expressed concerns about the reputational risks posed by these controversies, warning of potential “international embarrassment” for Ghana.

    Meanwhile, Rev. Victor Kusi Boateng, Secretary to the National Cathedral Board of Trustees, was cleared of allegations regarding dual identities. The report confirmed he holds a single passport under the name Kwabena Adu Gyamfi, refuting claims that he had a second passport with the name Victor Kusi Boateng.

    The government and the National Cathedral Board of Trustees have yet to respond to CHRAJ’s findings and recommendations.

  • National cathderal construction contract to Ribade Company Ltd unlawful, cancel it – CHRAJ

    National cathderal construction contract to Ribade Company Ltd unlawful, cancel it – CHRAJ

    The Commission on Human Rights and Administrative Justice (CHRAJ) has declared the construction contract awarded to Ribade Company Ltd for the National Cathedral project unlawful, recommending its cancellation and calling for a forensic audit and possible prosecution of the Board of Trustees overseeing the project.

    In a report dated November 22, 2024, CHRAJ cited several breaches of Ghana’s procurement laws, concluding that the contract was “void ab initio” for violating mandatory provisions of the Procurement Act, Act 663, as amended by Act 914. The Commission urged the Public Procurement Authority (PPA) to intervene and cancel the contract immediately.

    “The Board of the Public Procurement Authority should intervene to cancel the contract for the construction of the National Cathedral between the National Cathedral and Ribade Company as it has the power to do so under the Procurement Act,” the report, signed by CHRAJ Commissioner Joseph Whittal, stated.

    The investigation, triggered by a petition from North Tongu MP Samuel Okudzeto Ablakwa, uncovered irregularities surrounding GHS225,962,500.00 spent as “seed money” on-site preparation, contractor mobilization, fundraising, consultants, and symposia as of May 31, 2022. CHRAJ called for a forensic audit by the Auditor-General to assess value for money on the project, which remains incomplete.

    CHRAJ also expressed concerns about the potential reputational damage caused by the violations, noting that breaches of procurement laws could attract “international embarrassment to the country.”

    The report further recommended investigations and possible prosecution of the Board of Trustees for their role in awarding the contract in violation of procurement regulations.

    However, CHRAJ exonerated Rev. Victor Kusi Boateng, Secretary to the National Cathedral Board of Trustees, from allegations of possessing two passports with different names. The report clarified that Rev. Kusi Boateng, also known as Kwabena Adu Gyamfi, holds only one passport under the name Adu Gyamfi.

    The government and the National Cathedral Board of Trustees are yet to respond to the findings and recommendations.

  • NPP’s Nana B blames delay in the National Cathedral project on COVID-19 pandemic

    NPP’s Nana B blames delay in the National Cathedral project on COVID-19 pandemic

    National Organiser of the New Patriotic Party (NPP), Henry Nana Boakye, has explained the reasons behind the delay of the National Cathedral project, highlighting key factors that influenced its suspension.

    The National Cathedral, a highly anticipated project that has sparked mixed reactions from the public, is currently on hold.

    In an interview with Fiifi Pratt on Kingdom FM, monitored by MyNewsGh.com, Nana Boakye attributed the postponement to the effects of two significant global challenges: the COVID-19 pandemic and the ongoing Russia-Ukraine conflict.

    “The suspension of the National Cathedral project is largely due to unforeseen global challenges. The COVID-19 pandemic affected economies worldwide, including Ghana’s,” Nana Boakye explained during the interview.

    “The pandemic required a significant reallocation of resources. Financial resources that were originally set aside for the Cathedral were redirected to stabilise the economy and offer relief to Ghanaians in the midst of a crisis.”

    He elaborated on the immediate measures taken by the government to alleviate the hardships faced by Ghanaians, such as the provision of free electricity and water.

    “President Nana Akufo-Addo’s administration took decisive steps to support the people of Ghana during this difficult period,” Nana Boakye said.

    “Free electricity and water were provided to citizens to ease the burden of the pandemic.

    “These were essential steps to keep the country moving forward, and as a result, the resources for the Cathedral had to be paused.”

    The suspension of the National Cathedral project has sparked public debate, as many Ghanaians had embraced the vision of a monumental structure reflecting the nation’s Christian heritage.

    Addressing the concerns, Henry Nana Boakye defended the government’s decision, emphasizing that safeguarding the well-being of citizens during critical times took precedence over infrastructure development.

    “The government had to prioritize stabilizing the economy over pursuing large-scale projects. The focus was on ensuring Ghanaians could weather the pandemic without undue hardship,” Nana Boakye explained.

    He acknowledged the significance of the National Cathedral but stressed that the government’s primary goal during the crisis was to save lives and deliver essential services.

    Initially envisioned as a landmark for religious activities and a hub for tourism, the National Cathedral project has faced delays due to pressing national challenges. Despite this, Nana Boakye assured Ghanaians that the project remains on the agenda and will be revisited once the country’s economic conditions improve.

    “The National Cathedral is not abandoned. It’s simply on hold until the economic situation stabilizes,” he affirmed.

    “Once we have successfully navigated through these global challenges, we will refocus our efforts on completing this important national monument.”

  • National Cathedral project was Akufo-Addo’s vow, not the country’s – Sonnie Badu

    National Cathedral project was Akufo-Addo’s vow, not the country’s – Sonnie Badu

    Gospel artist Sonnie Badu has joined the ongoing discussion about the controversial National Cathedral project.

    In a recent interview with Empire FM, a station based in Takoradi, he expressed that the controversy surrounding the cathedral stems from the fact that it was a vow made to God by an individual rather than a collective commitment.

    Badu’s comments reflect the differing opinions on the cathedral’s significance and the funding behind it. This discussion highlights the complexities of faith-based projects and their implications within the community.

    “The reason why there are a lot of problems and confusion is that it was not a collective vow. It was an individualistic vow, and that is why there is a little bit of an issue there,” he said.

    Buttressing his point with some Biblical examples, Sonnie said people who made vows to God in the Biblical times ensured they honoured them.

    “If that was the vow that the President gave to God, then he needs to honour his vow. When you read the Bible, people made vows to God and they fulfilled them. So you asking me if it is necessary, I will say that if he vowed to God, he needs to honour.

    But that is very personal between him and his God. So it’s more like ‘I have promised God so I need to use my own money to fulfil it’. But when it’s like ‘I have promised God so let’s all do it’, that is where the whole confusion is,” he indicated.

    Sonnie Badu, however, noted that the idea of the National Cathedral is a good one.

    “A cathedral is a good thing. Just as there are a lot of mosques that Muslims put together for people to go there to worship, a National Cathedral, something for the nation, is not a bad idea,” he added.

    About the National Cathedral of Ghana

    The construction of the National Cathedral of Ghana is borne out of a promise that the President of Ghana, Nana Akufo-Addo, made to God.

    “I made a pledge to almighty God that He was gracious enough to grant my party, the NPP, and I victory in the 2016 elections after two unsuccessful attempts, so I will help build a cathedral to his glory and honour,” President Nana Akufo-Addo said at the sod-cutting ceremony in 2020.

    “The interdenominational national cathedral will help unify the Christian community and thereby help promote national unity and social cohesion,” he added.

    The Cathedral is supposed to provide a historic opportunity to put God at the centre of our nation’s affairs and serve as a symbol of our eternal and continuing gratitude to Him for the blessings He continues to shower and bestow on our nation.

  • Publish full 2020 audit report on National Cathedral amid 2021-24 probe – Ablakwa to Deloitte

    Publish full 2020 audit report on National Cathedral amid 2021-24 probe – Ablakwa to Deloitte

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has urged for the full publication of the 2020 audit report in reaction to the audit report on the National Cathedral project.

    He expressed his views in a post on X, highlighting concerns over the integrity of the information provided by the National Cathedral Secretariat, which claimed that audit firm Deloitte had cleared them for the period ending December 31, 2020.

    “I have observed quite a number of hirelings engage in a premature frenzy over a statement from the National Cathedral Secretariat claiming that audit firm Deloitte has purportedly cleared them for the period ending December 31, 2020. First of all, let me point out that Ghanaians demand a full publication of the said 2020 audit to draw our own informed conclusions. We shall not rely on the interpretations of an interested party.”

    Ablakwa cautioned against prematurely concluding that the 2020 audit, which only covers one year, indicates no adverse findings for the entire project.

    He emphasized, “I stress that it is grossly misleading to conclude that because of a 2020 audit report—a report covering only one year—then it means no adverse findings have been made for the entire project.”

    He noted that the statement from National Cathedral Board Chairman, Apostle Prof. Opoku Onyinah, acknowledged that audits for 2021, 2022, and 2023 remain outstanding.

    According to documents submitted to Parliament by former Finance Minister Ken Ofori-Atta, as of November 21, 2022, only 0.13% of financial releases for the project had been made by 2020.

    Ablakwa detailed this by stating, “Specifically, on 7th June, 2019, GHS445,000 (US$89,000) was released for the National Cathedral project. The remaining over 99% of releases happened after 2020.”

    He listed several post-2020 releases from the Finance Ministry:

    1. GHS80,525,461.84 (US$13,972,594.93) on March 5, 2021.
    2. GHS32,070,103.02 (US$5,564,827.84) on February 10, 2021.
    3. GHS142,762,500.00 (US$25,000,000.00) on October 29, 2021.
    4. GHS58,200,000.00 (US$10,000,000.00) on August 19, 2021.
    5. GHS25,000,000.00 (US$3,515,086.75) on March 31, 2022.

    He concluded that these releases totaled GHS339,003,064.86 (US$58,141,509.52), meaning the 2020 audit covered only a fraction of the actual financial activities related to the National Cathedral project.

    “As we await a full publication of the 2020 audit, we also eagerly await the completion of the 2021, 2022, and 2023 audits which will cover more than 99% of the releases made,” he stated.

    Ablakwa further remarked, “It would be interesting to see how any credible audit can conclude that the world’s most expensive pit which has now been upgraded to a National Cathedral Swimming Pool truly cost US$58.1 million. It would also be interesting to see how the litany of corrupt practices, diversions to Cary Summers and others, inflationary pricing, multiple legal breaches, demolishings, avoidable compensations, and criminal double identity payments will be cleaned up by any credible audit. The real comprehensive audit shall be conducted soon.”

    Meanwhile, the National Cathedral project is set to resume following the completion of the first audit report. Apostle Prof. Opoku Onyinah confirmed this development in a statement, stating that the audit conducted by Deloitte reviewed the project’s financial activities up to December 31, 2020. He emphasized that the audit was initiated to address public concerns over allegations of corruption and questionable expenditures.

    “The need for an audit was a key demand by church leadership and Ghanaians to establish the credibility of the project’s implementation. With the completion of this first report, preparations are underway for construction to resume,” he said, calling for renewed financial and prayer support for the project from the public.

    Construction had been suspended in 2022 due to financial constraints, but optimism remains regarding fundraising initiatives. Dr. Paul Opoku-Mensah, the Executive Director of the National Cathedral Secretariat, noted, “We are hoping that within the next couple of weeks, as part of our fundraising and other initiatives, we can begin work again.”

    Despite ongoing public debate about the necessity and transparency of the project, the government estimates that completion will require $450 million, with previous contributions from various church denominations amounting to GH¢2.21 million ($164,000), significantly less than needed.

  • National Cathedral Project overseer paid GHC21K monthly despite suspended work – Basintale

    National Cathedral Project overseer paid GHC21K monthly despite suspended work – Basintale

    Executive Director/Overseer of the National Cathedral Project, Dr Paul Opoku-Mensah, is reportedly being paid by the government despite a halt in construction works.

    Deputy National Communications Officer of the National Democratic Congress (NDC), Malik Basintale, claims that Dr Paul Opoku-Mensah is being paid GHC21,000 every month.

    He made the allegation during an interview on TV3’s New Day show. He said in 2022 during the suspension of the project, Dr Paul Opoku-Mensah and some board of trustees stated that they were not being paid for their work done. He shared the payslip he retrieved from the bank the overseer allegedly works with.

    “It was a bare face lie. This is from his bank, Absa, at the Tamale branch. Every month, the government pays him GHC21,000. He earns salary for nothing,” he said.

    The National Cathedral project was suspended in 2022. Dr. Paul Opoku-Mensah who brought this to light revealed that his outfit is really cash-strapped and needs support.

    “We have the contractors and their staff on site, but the work has been suspended. We are hoping that within the next couple of weeks, as part of our fundraising and other initiatives, we can begin work again,” he revealed.

    A year later, Dr. Paul Opoku-Mensah, gave a different submission. “There have been issues that the project has been suspended, but it hasn’t. Construction has stalled, but the National Cathedral is almost an institution; it’s going to be one of the largest institutions, so the work continues on a daily basis. In addition to funding, we are already engaging with those who can provide us with artifacts. Because if you want to turn it into a world-class site, you need historical artifacts,” he said.

    The construction of the cathedral has sparked debates across various sectors of society, focusing on the necessity and timing of such a large-scale structure, as well as concerns regarding the transparency and management of allocated funds.

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has accused the government of underreporting the amount of money spent on the national cathedral project. The Minister of State at the Finance Ministry, Abena Osei Asare, confirmed in Parliament on Wednesday, July 3, that the government has spent more than GH¢339 million on the National Cathedral project, which has been stalled for some time.

  • Man who broke national cathedral gate for ‘invasion’ by NDC protestors arrested

    Man who broke national cathedral gate for ‘invasion’ by NDC protestors arrested

    #FixTheCountry movement has announced the arrest and detention of its activist Ralph St Williams, known widely as Fellow Ghanaians who admitted to breaking the gate of the facility hosting the national cathedral project to allow demonstrators of the ‘Enough is Enough‘ protest to have access.

    He was arrested at the Kotoka International Airport while en route to Kumasi for mobilization activities in preparation for Saturday’s #SayNoToGalamsey protest, organized by Democracy Hub.

    In a statement on its X platform, the movement reported that “It appears that Ralph’s arrest stems from his peaceful participation in Tuesday’s ‘Enough is Enough’ demonstration, where he highlighted government mismanagement by opening the National Cathedral pit, a site that has already cost Ghana 58 million cedis, for symbolic swimming.”

    The movement further asserted that the arrest had been strategically timed to suppress his participation in the upcoming #SayNoToGalamsey protest and to intimidate activists fighting for transparency and environmental justice.

    “We strongly condemn this act and demand Ralph’s immediate release. Furthermore, we insist on an official apology from the authorities for this blatant attempt to silence critical voices,” it added.

    According to the movement, it will petition the Inspector General of Police, Dr George Akuffo Dampare, to address this situation.

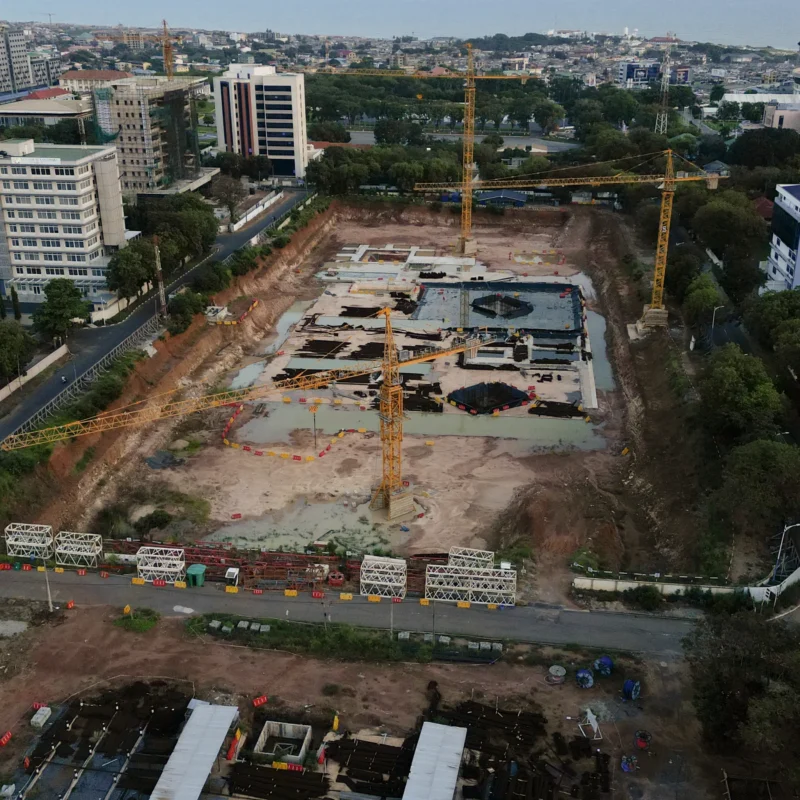

    A viral video revealing the current state of the stalled National Cathedral project which began in 2020 surfaced on social media on Tuesday, September 17.

    In the video shared by a Pro-NDC platform, there is the formation of a structure containing relatively small water. There were several individuals on the plot of land working. It is unknown what exactly they were engaged in.

    Also, some protestors of the NDC ‘Enough is Enough’ demonstration decided to swim in what appears to be a pool.

    Some X users have berated the government in response to the recent claims.

  • National Cathedral has become the world’s most expensive pool – Ato Forson

    National Cathedral has become the world’s most expensive pool – Ato Forson

    The Minority Leader in Parliament, Dr. Cassiel Ato Forson, has harshly criticized the National Cathedral project, referring to the construction site as the “world’s most expensive swimming pool.”

    In a Twitter post on Tuesday, September 17, Dr. Forson voiced his frustration over the stagnant progress of the project, which has seen little advancement despite years of development.

    He highlighted that, despite significant public funds being allocated, the site currently only features a water-filled pit.

    Dr. Forson drew a comparison to an abandoned galamsey site, questioning the project’s management and financial transparency.

    With millions of dollars already spent, including approximately $58 million, Dr. Forson accused the government of mismanagement and pointed out the project’s unfinished state.

    He further noted that the incomplete site is now being derisively called a “swimming pool” by critics, reflecting the widespread disillusionment among Ghanaians.

    The Minority Leader in Parliament, concluded his critique by urging the government to reassess its priorities.

    He called for a redirection of funds from the controversial and stagnant National Cathedral project to more urgent national concerns, such as healthcare, education, and infrastructure.

    Dr. Forson believes that addressing these critical areas would provide far greater benefits to the country than continuing with the stalled cathedral construction.

    “After breaking down newly-constructed residential buildings of judges, the Passport Office, private properties and claiming to have sunk over $58 million into a so called National Cathedral, demonstrators had unfettered access to the construction site for the very first time.”

    “The expenditure of a $58 million National Cathedral is comparable to an abandoned galamsey site.”

    “The world’s most expensive hole had collected so much water that it is now the world’s most expensive swimming pool. Some of the demonstrators had fun swimming in it,” he posted.

  • VIDEO: NDC ‘Enough is Enough’ protestors swim in National Cathedral ‘pool’

    VIDEO: NDC ‘Enough is Enough’ protestors swim in National Cathedral ‘pool’

    A viral video said to reveal the current state of the stalled National Cathedral project which began in 2020 has surfaced on social media.

    In the video shared by a Pro-NDC platform, there is the formation of a structure containing relatively small water. There were several individuals on the plot of land working. It is unknown what exactly they were engaged in.

    Also, some protestors of the NDC ‘Enough is Enough’ demonstration decided to swim in what appears to be a pool.

    Some X users have berated the government in response to the recent claims.

    “The whole Ghana the only river that is clean is the river national cathedral,” “Akuffo Addo managed to scam God too …Eish,” some users wrote.

    The construction of the cathedral has sparked debates across various sectors of society, focusing on the necessity and timing of such a large-scale structure, as well as concerns regarding the transparency and management of allocated funds.

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has accused the government of underreporting the amount of money spent on the national cathedral project. The Minister of State at the Finance Ministry, Abena Osei Asare, confirmed in Parliament on Wednesday, July 3, that the government has spent more than GH¢339 million on the National Cathedral project, which has been stalled for some time.

    She responded to an urgent query raised by the Deputy Majority Leader, Patricia Appiagyei, seeking clarification on the funds allocated and expended on the contentious project. The Deputy Finance Minister also mentioned that the accounts of the National Cathedral are currently undergoing audit.

    “The total releases made for the National Cathedral by the government to date remain at GH¢339 million. This figure comprises GH¢225 million paid to the National Cathedral Secretariat, and GH¢113 million paid directly to the project consultant.

    “There was a value-for-money audit done on the project in 2021. Also, a statutory audit of the National Cathedral of Ghana accounts by Deloitte Ghana was started in July 2023 and is ongoing.

    “Auditors had concluded the audit of the 18-month account ended December 31, 2020. Meanwhile, preparations are in place for the auditors to complete the remaining accounts for the periods ended December 31, 2021, 2022 and 2023.”

    But according to Mr Ablakwa, the figure revealed by the Minister does not reflect the true picture on the ground.

    In a post on X, he claimed that GHS379million had been spent. He noted that the Minister stated that GHS33,444,704.74 was raised in Ghana and US$427,701 was raised in the US. However, he says the US figure is significantly different from what was declared to US tax authorities.

    “That notwithstanding, we would have to add these private donations to the taxes illegally withdrawn for the project in order to have a more accurate picture. Tax Withdrawals — GHS339,003,064.86 Private Donations (Ghana) — GHS33,444,704.74 Private Donations (USA) — US$427,701.00,” he added.

  • Akufo-Addo has built the world’s most expensive swimming pool – Ato Forson

    Akufo-Addo has built the world’s most expensive swimming pool – Ato Forson

    Minority Leader in Parliament, Dr. Cassiel Ato Forson, has taken a sharp jab at the stalled National Cathedral project, labeling the construction site as the “world’s most expensive swimming pool.”

    In a Twitter post on Tuesday, September 17, Dr. Forson expressed his frustration over the lack of visible progress on the project, which has been under development for several years.

    Dr. Forson highlighted the significant public funds that have been poured into the project, stating that the only visible feature on the site is a water-filled pit. He likened the situation to an abandoned galamsey (illegal mining) site and questioned the management of the project, including the transparency surrounding its finances.

    Despite millions of dollars allocated to the National Cathedral, Dr. Forson emphasized that the site remains largely incomplete.

    “After breaking down newly-constructed residential buildings of judges, the Passport Office, private properties and claiming to have sunk over $58 million into a so-called National Cathedral, demonstrators had unfettered access to the construction site for the very first time,” he noted.

    Dr. Forson criticized the government for what he described as mismanagement, noting that approximately $58 million has been spent so far without significant progress. He pointed out that the unfinished site, which has been filled with water, has drawn mockery, with some referring to it as a “swimming pool.”

    He continued, “The world’s most expensive hole had collected so much water that it is now the world’s most expensive swimming pool. Some of the demonstrators had fun swimming in it,” adding that the state of the project symbolizes the disappointment felt by many Ghanaians.

    The Minority Leader further urged the government to reconsider its priorities, suggesting that funds earmarked for the National Cathedral should be redirected towards more urgent national needs such as healthcare, education, and infrastructure, which he believes would provide greater benefit to the country than the controversial and stagnant project.

    Dr. Forson’s criticism adds to growing concerns from various quarters about the management and transparency of the National Cathedral project, which has been marred by delays and controversy since its inception.

    https://twitter.com/SIKAOFFICIAL1/status/1836157279013400578/video/2
  • Alleged video of National Cathedral project shows pond-like structure

    Alleged video of National Cathedral project shows pond-like structure

    A viral video said to reveal the current state of the stalled National Cathedral project which began in 2020 has surfaced on social media.

    In the video shared by a Pro-NDC platform, there is the formation of a structure containing relatively small water. There were several individuals on the plot of land working. It is unknown what exactly they were engaged in.

    Some X users have berated the government in response to the recent claims.

    “The whole Ghana the only river that is clean is the river national cathedral,” “Akuffo Addo managed to scam God too …Eish,” some users wrote.

    The construction of the cathedral has sparked debates across various sectors of society, focusing on the necessity and timing of such a large-scale structure, as well as concerns regarding the transparency and management of allocated funds.

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has accused the government of underreporting the amount of money spent on the national cathedral project. The Minister of State at the Finance Ministry, Abena Osei Asare, confirmed in Parliament on Wednesday, July 3, that the government has spent more than GH¢339 million on the National Cathedral project, which has been stalled for some time.

    She responded to an urgent query raised by the Deputy Majority Leader, Patricia Appiagyei, seeking clarification on the funds allocated and expended on the contentious project. The Deputy Finance Minister also mentioned that the accounts of the National Cathedral are currently undergoing audit.

    “The total releases made for the National Cathedral by the government to date remain at GH¢339 million. This figure comprises GH¢225 million paid to the National Cathedral Secretariat, and GH¢113 million paid directly to the project consultant.

    “There was a value-for-money audit done on the project in 2021. Also, a statutory audit of the National Cathedral of Ghana accounts by Deloitte Ghana was started in July 2023 and is ongoing.

    “Auditors had concluded the audit of the 18-month account ended December 31, 2020. Meanwhile, preparations are in place for the auditors to complete the remaining accounts for the periods ended December 31, 2021, 2022 and 2023.”

    But according to Mr Ablakwa, the figure revealed by the Minister does not reflect the true picture on the ground.

    In a post on X, he claimed that GHS379million had been spent. He noted that the Minister stated that GHS33,444,704.74 was raised in Ghana and US$427,701 was raised in the US. However, he says the US figure is significantly different from what was declared to US tax authorities.

    “That notwithstanding, we would have to add these private donations to the taxes illegally withdrawn for the project in order to have a more accurate picture. Tax Withdrawals — GHS339,003,064.86 Private Donations (Ghana) — GHS33,444,704.74 Private Donations (USA) — US$427,701.00,” he added.

  • Revealed: Duncan-Williams opens up on his exit from National Cathedral Board

    Revealed: Duncan-Williams opens up on his exit from National Cathedral Board

    Archbishop Nicholas Duncan-Williams, General Overseer of Action Chapel International, has publicly explained his decision to resign from the National Cathedral of Ghana’s Board of Trustees.

    In a recent statement shared by GNA on August 27, 2024, Duncan-Williams revealed that his departure was motivated by a belief that his presence was no longer making an impact.

    “I left the National Cathedral’s Board because I felt I couldn’t make a difference there,” the founder of Action Chapel International said.

    Duncan-Williams and Rev Eastwood Anaba of Eastwood Anaba Ministries both stepped down from the Board in October 2023.

    Their resignation was formally communicated to President Akufo-Addo, citing increasing concerns over the project’s transparency and accountability as their reasons for leaving.

    “Despite our prayers, best hopes and wishes, unfortunately, a needed audit to help restore public confidence and trust in this consequential project has not been enacted to the best of our knowledge. Since January 2023, we have awaited news, to no avail, regarding the findings of the audit. We, therefore, regret that as a matter of conscience and faith, we hereby submit to you our resignation from the Board of Trustees of the National Cathedral,” the statement said.

    They clarified that their resignation should not be seen as a challenge to the National Cathedral’s vision or goals.

    Instead, they emphasized that they believe their departure serves to advance the project with a focus on integrity, efficiency, and quality, while also maintaining and strengthening public trust and support.

  • Gov’t paid David Adjaye GHC32M for interviewing contractors for National Cathedral project – Okudzeto

    Gov’t paid David Adjaye GHC32M for interviewing contractors for National Cathedral project – Okudzeto

    Member of Parliament for North Tongu, Samuel Okudeto Ablakwa, has provided a startling revelation with regards to the National Cathedral project which has seen construction works suspended due to lack of funds.

    According to Mr Ablakwa, payment vouchers intercepted by his outfit indicate that the Consultant of the project deemed controversial, Sir David Adjaye, was paid an amount of GHS32.07 million for opening bids and interviewing contractors.

    This amount, per the document sighted by The Independent Ghana, was paid in 2021.

    “Latest intercepted payment vouchers reveal how David Adjaye was paid an incredible GHS32.07million on February 18, 2021 just for opening bids and interviewing contractors for Akufo-Addo’s sleazy National Cathedral project,” he wrote on August 14.

    He added that “Architects of considerable renown and project management experts I have engaged are in total shock.” I can’t wait for judgement day after 7th December, 2024.”

    Mr Ablakwa further registered his support for the NDC flagbearer, John Mahama’s resolve to ensure the law goes after every government official who has in one way or another caused financial loss to the station through corruption.

    “This is another reason why I am in total agreement with incoming President John Mahama that if we deal ruthlessly with blatant corruption and reckless dissipation of state resources such as the National Cathedral heist, we can comfortably fund the NDC’s No-Fees-Stress Policy of paying admission fees for first year tertiary students. Corruption and State Capture shall surely be defeated!”

    In January 2023, the Executive Director of the National Cathedral Secretariat, Dr. Paul Poku Mensah, revealed that the Akufo-Addo government had spent a whopping amount of almost GH¢340 million on the construction of the controversial national cathedral by the close of December 2022.

    This includes an amount of GH¢113 million paid directly to the Consultant, Sir David Adjaye and GH¢225 million paid directly to the Secretariat.

    Dr. Paul Poku Mensah made this known in a status report on the National Cathedral delivered at the Bible Reading Marathon Thanksgiving Service at the project site on Tuesday, January 2, 2023.

    “For purposes of clarity, I want to report a verbatim memo I sent on this issue dated 19th January 2022 and addressed to the Clerk of Parliament. The indication was that the government has given us GH¢339 million and we could account for GH¢225 million leaving GH¢114 million missing. Here, I quote what I wrote to the Clerk.”

    “As we indicated to the Committee on Thursday, December 15, 2022, the total amount paid by the government of Ghana to the National Cathedral project is GH¢339 million. This total is made up of the following: the amount paid directly to the National Cathedral Secretariat is GH¢225 million. The amount paid directly to the Consultant, Adjaye Associates & Design Team is GH¢113.040.54.67 million The two payments total GH¢339.003.064.86.”

    “So, there are no missing funds that could not be accounted for. Secondly, the detailed account for these funds was provided to Parliament on December 15, 2022, by the Secretariat. In the case of the accounting from the Secretariat, this involves among others, total payments made to the contractor, and total payments made to the Bible Museum and Biblical Gardens Design Team.”

    Dr. Paul Opoku Mensah expressed displeasure over what he described as a misrepresentation of facts on the project by some Members of Parliament.

    “While projects of this nature will always have discontent, we are nonetheless concerned about the misrepresentations particularly when it comes from Members of Parliament. For instance, the continued misrepresentation of the contract to the consultants is worrying as none of the amount bandied around comes anywhere near the contract amount.

    Rather than 34% that they said we’d paid the architect, actually, the contract figure is 12.5% when the Ministry of Works and Housing allows for 15.5%. And the 12.5% will not change irrespective of what happens to the total cost. More critically, the contract is not for an architect, but for a set of consultants’ services involving 15 international and Ghanaian firms of which Sir David Adjaye Associates is the lead consultant,” he added.

  • Akufo-Addo’s ex-gratia must be frozen to fund National Cathedral – Prof Gyampo

    Akufo-Addo’s ex-gratia must be frozen to fund National Cathedral – Prof Gyampo

    A political science lecturer at the University of Ghana, Professor Ransford Gyampo, has proposed an unconventional method for raising funds to reclaim the land used for the National Cathedral’s foundation.

    During a panel discussion on TV3, Professor Gyampo argued that President Nana Addo Dankwa Akufo-Addo should face personal losses for his involvement in the National Cathedral’s construction.

    Gyampo suggested that the state should freeze President Akufo-Addo’s ex-gratia and use the funds for land reclamation.

    Despite questioning the legality of his own proposal, Gyampo insisted that Akufo-Addo should be held accountable for the funds spent on the project.

    He added that the President and his ministers involved in allocating state funds for the Cathedral should be sued for causing financial loss to the state.

    “Somebody must be sued for the construction of the National Cathedral. Somebody must be sued for causing financial loss to the state. President Akufo-Addo must suffer some consequences, so if possible for us to freeze his gratuity to be used in paying for the covering of the Cathedral, let’s do it. If that is not enough, then we sue him and his appointees,” he said.

    The National Cathedral, which President Akufo-Addo deemed a ‘priority among priorities,’ has stalled due to funding issues.

    Reverend Victor Kusi Boateng, Executive Secretary of the National Cathedral’s Board of Trustees, stated that $250 million is needed to complete the project.

    “If we could raise an amount of $200 million to $250 million, the National Cathedral will be completed. Let’s look at the advantages the Cathedral will bring to Ghana and its financial benefits as a nation. God has blessed us, we need to come together and thank Him.”

    “Washington Museum in construction cost $600 million, but after the completion of the Cathedral, Ghana shall have a Bible museum of Africa that will in terms of space, content, and technology be higher than the American Museum that cost them $600 million.

    “All costs together, our Cathedral, Biblical Museum, and Biblical Gardens is just around $300 million, and ours is bigger than the American Bible Museum that costs $600 million. If you look in-depth into the data, you realize that although $300 million is money, compared to the $600 million, we’ve done well.”

  • GHC379m spent on National Cathedral hole not GHC339m – Okudzeto

    GHC379m spent on National Cathedral hole not GHC339m – Okudzeto

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has accused the government of underreporting the amount of money spent on the national cathedral project.

    The Minister of State at the Finance Ministry, Abena Osei Asare, confirmed in Parliament on Wednesday, July 3, that the government has spent more than GH¢339 million on the National Cathedral project, which has been stalled for some time.

    She responded to an urgent query raised by the Deputy Majority Leader, Patricia Appiagyei, seeking clarification on the funds allocated and expended on the contentious project.

    The Deputy Finance Minister also mentioned that the accounts of the National Cathedral are currently undergoing audit.

    “The total releases made for the National Cathedral by the government to date remain at GH¢339 million. This figure comprises GH¢225 million paid to the National Cathedral Secretariat, and GH¢113 million paid directly to the project consultant.

    “There was a value-for-money audit done on the project in 2021. Also, a statutory audit of the National Cathedral of Ghana accounts by Deloitte Ghana was started in July 2023 and is ongoing.

    “Auditors had concluded the audit of the 18-month account ended December 31, 2020. Meanwhile, preparations are in place for the auditors to complete the remaining accounts for the periods ended December 31, 2021, 2022 and 2023.”

    But according to Mr Ablakwa, the figure revealed by the Minister does not reflect the true picture on the ground.

    In a post on X, he claimed that GHS379million has been spent.

    He noted that the Minister stated that GHS33,444,704.74 was raised in Ghana and US$427,701 was raised in the US.

    However, he says the US figure is significantly different from what was declared to US tax authorities.

    “That notwithstanding, we would have to add these private donations to the taxes illegally withdrawn for the project in order to have a more accurate picture. Tax Withdrawals — GHS339,003,064.86 Private Donations (Ghana) — GHS33,444,704.74 Private Donations (USA) — US$427,701.00,” he added.

    The National Cathedral project, which began in 2020, has been surrounded by controversy from the outset. Its construction has sparked debates across various sectors of society, focusing on the necessity and timing of such a large-scale structure, as well as concerns regarding the transparency and management of allocated funds.

  • Present audit report on National Cathedral project to Parliament – Minority to gov’t

    Present audit report on National Cathedral project to Parliament – Minority to gov’t

    The Minority in Parliament has called on the government to release the full value for money audit report allegedly conducted on the National Cathedral project.

    This demand follows a revelation by the Minister of State at the Finance Ministry, Abena Osei Asare, that the government had conducted a value-for-money audit before disbursing funds for the stalled project.

    During a parliamentary session, Minister Osei Asare disclosed that a total of 339 million Ghana cedis had been released for the National Cathedral project, which remains at the foundation level.

    The funds include GHC225 million paid to the National Cathedral Secretariat and GHC113 million paid directly to the project consultant.

    “There was a value-for-money audit done on the project in 2021. Also, a statutory audit of the National Cathedral of Ghana accounts by Deloitte Ghana was started in July 2023 and is ongoing. Auditors had concluded the audit of the 18-month account ended on December 31, 2020. Meanwhile, preparations are in place for the auditors to complete the remaining accounts for the periods ending December 31, 2021, 2022, and 2023,” explained Osei Asare.

    In response, Samuel Okudzeto Ablakwa, Member of Parliament for North Tongu, demanded the release of the audit report. Mr Ablakwa asserted that the full report must be made available to Parliament if it indeed exists.

    “All these claims that they have a value for money report, if that report exists, what you do is that you bring that report to the House so that we can peruse the document. It wasn’t brought to us. We are demanding those documents,” stated Ablakwa.

    He further called for a comprehensive parliamentary probe into the project, citing numerous issues that have arisen since its inception.

    “This National Cathedral project has opened a can of worms from inflation pricing, procurement breaches, constitutional violations, conflict of interest, double identity, and demolition of properties; it is a whole mess that one parliamentary question cannot resolve. What we need is a full-scale parliamentary inquiry to go into the entire project,” he stressed.

    Since the commencement of the National Cathedral project in 2020, it has been mired in controversy and scandal, particularly highlighted by the opposition National Democratic Congress.

    The project has sparked widespread debate, with many questioning its necessity and timing, as well as criticizing the lack of transparency in the management of the allocated funds.

  • Govt disbursed over GHS339m for National Cathedral project since 2020 – Abena Osei Asare

    Govt disbursed over GHS339m for National Cathedral project since 2020 – Abena Osei Asare

    The government has spent more than GH¢339 million on the National Cathedral project, which has been stalled for some time.

    This significant expenditure was confirmed in Parliament on Wednesday, July 3, by the Minister of State at the Finance Ministry, Abena Osei Asare.

    She responded to an urgent query raised by the Deputy Majority Leader, Patricia Appiagyei, seeking clarification on the funds allocated and expended on the contentious project.

    The Deputy Finance Minister also mentioned that the accounts of the National Cathedral are currently undergoing audit.

    “The total releases made for the National Cathedral by the government to date remain at GH¢339 million. This figure comprises GH¢225 million paid to the National Cathedral Secretariat, and GH¢113 million paid directly to the project consultant.

    “There was a value-for-money audit done on the project in 2021. Also, a statutory audit of the National Cathedral of Ghana accounts by Deloitte Ghana was started in July 2023 and is ongoing.

    “Auditors had concluded the audit of the 18-month account ended December 31, 2020. Meanwhile, preparations are in place for the auditors to complete the remaining accounts for the periods ended December 31, 2021, 2022 and 2023.”

    The National Cathedral project, which began in 2020, has been surrounded by controversy from the outset. Its construction has sparked debates across various sectors of society, focusing on the necessity and timing of such a large-scale structure, as well as concerns regarding the transparency and management of allocated funds.

  • Finance Minister updates Parliament on cost of National Cathedral project today

    Finance Minister updates Parliament on cost of National Cathedral project today

    The Minister for Finance is scheduled to appear before Parliament on Wednesday, July 3, to address an urgent question from Deputy Majority Leader Patricia Appiagyei about expenditures related to the National Cathedral project.

    Majority Leader Alexander Afenyo-Markin has confirmed that the Minister will be asked about the financial specifics of the National Cathedral project and whether a value-for-money audit has been conducted.

    Deputy Majority Leader Appiagyei has highlighted the significance of the Minister’s appearance to ensure transparency in the use of public funds for the National Cathedral.

    The Minister is expected to provide detailed information on the project’s finances and clarify if a value-for-money audit has been performed, aiming to ensure accountability and transparency.

    Majority Leader Afenyo-Markin made these announcements on the floor of Parliament on Friday, June 28.

    Meanwhile, ahead of the Finance Minister’s appearance, the Minority is calling for broader accountability measures from the government.

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has urged the Speaker to enforce the House’s decision to establish a bipartisan committee to investigate issues surrounding the project.

  • Finance Minister to address parliament about expenditure on National Cathedral tomorrow

    The Minister for Finance is scheduled to appear before Parliament on Wednesday, July 3, to address an urgent question from Deputy Majority Leader Patricia Appiagyei about expenditures related to the National Cathedral project.

    Majority Leader Alexander Afenyo-Markin has confirmed that the Minister will be asked about the financial specifics of the National Cathedral project and whether a value-for-money audit has been conducted.

    Deputy Majority Leader Appiagyei has highlighted the significance of the Minister’s appearance to ensure transparency in the use of public funds for the National Cathedral.

    The Minister is expected to provide detailed information on the project’s finances and clarify if a value-for-money audit has been performed, aiming to ensure accountability and transparency.

    Majority Leader Afenyo-Markin made these announcements on the floor of Parliament on Friday, June 28.

    Meanwhile, ahead of the Finance Minister’s appearance, the Minority is calling for broader accountability measures from the government.

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has urged the Speaker to enforce the House’s decision to establish a bipartisan committee to investigate issues surrounding the project.

  • Parliament summons Finance Minister to discuss National Cathedral project expenditure

    Parliament summons Finance Minister to discuss National Cathedral project expenditure

    The Minister of Finance, Dr Mohammed Anim Adam is scheduled to appear before Parliament on Wednesday, July 3, 2024, to address an urgent question posed by Deputy Majority Leader Patricia Appiagyei regarding the expenditure of the National Cathedral project.

    Majority Leader Alexander Afenyo-Markin has stated that the Minister will be required to provide detailed information on the project’s expenditures and confirm whether a value-for-money audit has been conducted.

    Deputy Majority Leader Appiagyei has emphasized the importance of the Minister’s appearance to ensure transparency in the use of public funds for the National Cathedral.

    The Minister is expected to furnish comprehensive financial details of the project and clarify whether a value-for-money audit has been conducted to ensure accountability and transparency.

    Majority Leader Afenyo-Markin announced these proceedings on the floor of Parliament on Friday, June 28, 2024.

    Ahead of the Finance Minister’s appearance, the Minority is pressing for broader accountability measures from the government.

    Samuel Okudzeto Ablakwa, MP for North Tongu Constituency, has urged the Speaker to enforce the House’s decision to establish a bipartisan committee to investigate the issues surrounding the project.

  • National Cathedral is on hold perhaps God wants Bawumia to dedicate it – Prophet Amoako

    National Cathedral is on hold perhaps God wants Bawumia to dedicate it – Prophet Amoako

    A prominent religious leader has urged Vice President, Mahamudu Bawumia to lead efforts in completing the contentious National Cathedral of Ghana project.

    Prophet Amoako Attah expressed his belief that it would be significant if a major Christian place of worship were completed and dedicated by a Muslim President, potentially Bawumia if he assumes the presidency.

    Speaking at an event in Accra attended by Bawumia, the flagbearer of the New Patriotic Party (NPP), and several clergymen from the Greater Accra Region as part of his campaign, Attah suggested that it might be prophetic for Bawumia to play a role in fulfilling the completion of the Cathedral.

    Drawing parallels with historical examples, Attah referenced how King Herod, though not Jewish, oversaw the construction of temples for Jews in Israel.

    “Maybe prophetically, the reason why that hole is there, is that maybe, God wants you to fulfill (completion of Cathedral),” he said in comments after Bawumia had addressed the issue.

    “So it is going to be prophetic that once upon a time a temple was built and the president who dedicated the temple for the Christians was a Muslim,” he added tasking Bawumia to rope in the private sector to complete the stalled project.

    He stressed the necessity for collaboration between the church and government, highlighting the need for discussions on the way forward and the potential involvement of private resources to complete the Cathedral.

  • You will fail God if you leave office without completing National Cathedral – Prophet Oduro to Akufo-Addo

    Founder of Alabaster International Ministries, Prophet Dr. Kofi Oduro, has delivered a resolute message to President Akufo-Addo.

    He warned that failing to meet the 2025 deadline for completing the National Cathedral project would signify a failure of Akufo-Addo’s leadership and accountability before both the country and God.

    On a flyer shared by Joy News, the Prophet stressed the critical importance of fulfilling commitments regarding the National Cathedral.

    “Your excellency Akufo-Addo if you leave office without this project completed, you have failed your tenure and God.

    “If the Cathedral doesn’t come up by 7th January 2025, your excellency you have failed your tenure and God,” the flyer added.

    The National Cathedral project, envisioned as a beacon of unity and faith for all Ghanaians, has faced scrutiny and debate.

    The National Cathedral project holds profound significance, symbolizing Ghana’s unity and spiritual heritage.

    As the deadline approaches, the pressure mounts on President Akufo-Addo’s administration to deliver on its promises and ensure the project’s timely completion.

  • Govt draining pockets of ordinary Ghanaians in the name National Cathedral – Ansa-Asare

    Govt draining pockets of ordinary Ghanaians in the name National Cathedral – Ansa-Asare

    The Akufo-Addo administration is squeezing the last drop from every Ghanaian to fund the President’s National Cathedral dream, according to former Ghana School of Law Director Kwaku Ansa-Asare.

    Mr. Ansa-Asare described the Akufo-Addo government as the most corrupt in Ghana’s history, highlighting the substantial amount of taxpayers’ money invested in the President’s personal pledge to build a national cathedral.

    “We want to build the Cathedral, so, we take the monies. They used the Cathedral to milk us. the government is milking the ordinary Ghanaian,” he complained.

    In January 2023, Dr. Paul Opoku Mensah, the Executive Director of the National Cathedral Secretariat, denied that any government-allocated funds for the cathedral project had gone missing.

    At the project site, he informed President Nana Akufo-Addo and the media on Tuesday, January 2, 2023, that:

    “For purposes of clarity, I want to report a verbatim memo I sent on this issue dated 19th January 2022 and addressed to the Clerk of Parliament.”

    “The indication was that the government has given us GHS339 million and we could account for GHS225 million leaving GHS114 million missing.”

    ”Here, I quote what I wrote to the Clerk. ‘As we indicated to the Committee on Thursday, December 15, 2022, the total amount paid by the government of Ghana to the National Cathedral project is GHS339 million. This total is made up of the following: the amount paid directly to the National Cathedral Secretariat is GHS225 million. The amount paid directly to the Consultant, Adjaye Associates & Design Team is GHS113.040.54.67 million. The two payments total GHS339.003.064.86’.”

    Dr Opoku Mensah, thus, dispelled claims that some monies allocated for the construction of the cathedral cannot be accounted for.

    “So, there are no missing funds that could not be accounted for. Secondly, the detailed account for these funds was provided to Parliament on December 15, 2022, by the Secretariat. In the case of the accounting from the Secretariat, this involves among others, total payments made to the contractor, and total payments made to the Bible Museum and Biblical Gardens Design Team.”

    He also conveyed the secretariat’s dissatisfaction with certain Members of Parliament for, in his words, misrepresenting the project’s realities.

    “While projects of this nature will always have discontent, we are nonetheless concerned about the misrepresentations particularly when it comes from Members of Parliament.”

    “For instance, the continued misrepresentation of the contract to the consultants is worrying as none of the amount bandied around comes anywhere near the contract amount.”

    “Rather than 34% that they said we’d paid the architect, actually, the contract figure is 12.5% when the Ministry of Works and Housing allows for 15.5%. And the 12.5% will not change irrespective of what happens to the total cost.”

    “More critically, the contract is not for an architect, but for a set of consultants’ services involving 15 international and Ghanaian firms of which Sir David Adjaye Associates is the lead consultant,” he said.

    In January 2023, Dr. Paul Opoku Mensah, the Executive Director of the National Cathedral Secretariat, denied that any government-allocated funds for the cathedral project had gone missing.

    At the project site, he informed President Nana Akufo-Addo and the media on Tuesday, January 2, 2023, that:

    “For purposes of clarity, I want to report a verbatim memo I sent on this issue dated 19th January 2022 and addressed to the Clerk of Parliament.”

    “The indication was that the government has given us GHS339 million and we could account for GHS225 million leaving GHS114 million missing.”

    ”Here, I quote what I wrote to the Clerk. ‘As we indicated to the Committee on Thursday, December 15, 2022, the total amount paid by the government of Ghana to the National Cathedral project is GHS339 million. This total is made up of the following: the amount paid directly to the National Cathedral Secretariat is GHS225 million. The amount paid directly to the Consultant, Adjaye Associates & Design Team is GHS113.040.54.67 million. The two payments total GHS339.003.064.86′.”

    Dr Opoku Mensah, thus, dispelled claims that some monies allocated for the construction of the cathedral cannot be accounted for.

    “So, there are no missing funds that could not be accounted for. Secondly, the detailed account for these funds was provided to Parliament on December 15, 2022, by the Secretariat. In the case of the accounting from the Secretariat, this involves among others, total payments made to the contractor, and total payments made to the Bible Museum and Biblical Gardens Design Team.”

    He also expressed the secretariat’s displeasure over what he described as a misrepresentation of facts on the project by some Members of Parliament.

    “While projects of this nature will always have discontent, we are nonetheless concerned about the misrepresentations particularly when it comes from Members of Parliament.”

    “For instance, the continued misrepresentation of the contract to the consultants is worrying as none of the amount bandied around comes anywhere near the contract amount.”

    “Rather than 34% that they said we’d paid the architect, actually, the contract figure is 12.5% when the Ministry of Works and Housing allows for 15.5%. And the 12.5% will not change irrespective of what happens to the total cost.”

    “More critically, the contract is not for an architect, but for a set of consultants’ services involving 15 international and Ghanaian firms of which Sir David Adjaye Associates is the lead consultant,” he said.

    In the 2023 budget, government allocated a sum of GHS80million towards the construction of the cathedral, however, the Minority succeeded in disapproving it.

    In the view of Mr Ansa-Asare, scandals like the cathedral saga, are a testament to how endemic corruption has been in the Akufo-Addo government.

    “I don’t have the statistics but watching the political terrain, and the various approaches to the fight against corruption, I would say that this is the worst government we have ever had to combat corruption,” he told Accra-based Citi FM in an interview.

    “I don’t have the statistics but watching the political terrain, and the various approaches to the fight against corruption, I would say that this is the worst government we have ever had to combat corruption,” he told Accra-based Citi FM in an interview.

    He continued: “I have said it before. I granted an interview and I said: ‘Any government that will come and shout from the rooftop, ‘I’m going to fight corruption’, will be the worst in terms of fighting corruption. That will be the most corrupt government.’”

    “Akufo-Addo’s government is the worst ever, the most corrupt government we have ever had,” Mr Ansa-Asare asserted.

    Comparing this government to others in the Fourth Republic, Mr Ansa-Asare scored it ‘F’ as far as corruption fight is concerned.

    “At least, I have witnessed Rawlings, Kufuor, Mills and Mahama. If I have to score them and award them marks, the last and worst will be the current government, followed by John Mahama’s government. Mills will be first, Kufuor second, Rawlings third, Akufo-Addo last, in terms of grade one to four.”

    “We’re all witnesses to scandal after scandal. The latest is the [Pwalugu] dam. We don’t even know where the dam is. We don’t know what has happened, but there’s a dam.” “One-District-One-Factory: the monies.”

  • It’s a 419 – Kofi Amoabeng reacts to National Cathedral construction

    It’s a 419 – Kofi Amoabeng reacts to National Cathedral construction

    Founder of the defunct UT Bank and UT Holdings, Capt. Rtd. Prince Kofi Amoabeng, has stated that the initiation of the National Cathedral project is a camouflage scheme set up by government.

    Speaking to Joy News he explained that the initiative has been put forth by the Akufo-Addo-led administration as a way to rip Ghanaians off their labour.

    He raised concerns regarding the government’s failure to prioritize effectively.

    To him, the significant investment in the National Cathedral, a project he deemed non-urgent, could have instead been directed towards other paramount stalled projects across the nation.

    “Is a 419 really? Of course. How can they put state money and whatever funding that they said they had into putting that pit there? But you want me to have enemies in the government. I’m not trying to be enemies for you.That’s why I’m saying 419. 419 is when they dupe you of your money, you don’t get anything out of it. So let’s leave it at 419. But do you think there’s a use we could put that to in the future? I don’t. I think we have to consult architects and things like that. Maybe they could put up some edifice and use the whatever there as a basement or.”

    Controversies and opposition have surrounded the National Cathedral project, with questions raised about its relevance given Ghana’s economic challenges.

    Despite public resistance, President Akufo-Addo remains steadfast in his commitment to proceed with the construction.

    To address recent concerns, the Board of Trustees opted for a “normal statutory audit” in January.

    A proposal from the Minority caucus suggested a comprehensive investigation into the project and related matters.

    In response, the audit firm Deloitte, which handled the registration of the National Cathedral, was tasked with conducting the audit.

    The committee overseeing the process aims to provide suitable recommendations for Parliament’s consideration.

    Apostle Prof. Opoku Onyinah, Chairman of the Board, stated, “The Board is already in discussions to engage Deloitte, which accepted to be the auditors when the National Cathedral was registered, to commence the normal statutory audit”.

    Amidst these developments, accusations have arisen against Rev. Kusi Boateng, Secretary of the Board of Trustees, alleging multiple identities and receiving 2.6 million cedis without rendering any services, as claimed by Okudzeto Ablakwa.

  • Money invested in National Cathedral could have addressed educational challenges – Clement Apaak

    Money invested in National Cathedral could have addressed educational challenges – Clement Apaak

    The ranking member on the parliament’s committee on education, Clement Apaak, has stated that the funds allocated to the National Cathedral project could have been better utilized to address infrastructure challenges within the education sector.

    During an interview with TV3, Dr. Apaak emphasized that despite the paramount importance of the education sector, it has not received the necessary attention under the Akufo-Addo-led administration.

    He criticized the government’s failure to prioritize effectively.

    Dr. Apaak pointed out that the significant investment in the National Cathedral, a project deemed non-urgent, could have instead been directed towards providing a conducive learning environment for school children across the nation.

    “I think it’s an issue of prioritization, for example, look at the quantum of money stake in public resources invested towards the construction of the National Cathedral.

    “If those monies were to be applied to procure furniture I believe we would have been talking about millions of pieces of furniture procured and distributed but Akufo-Addo and his government prioritised the construction of the Cathedral which has been described now as the most expensive on the surface of the earth,” he added.

    He noted the alarming statistic of over 5,000 schools operating under trees in Ghana.

    The Builsa South lawmaker also criticized the persistence of this issue under the current administration, contrasting it with the efforts of the previous Mahama administration, which he claimed had made substantial progress in eradicating schools under trees.

    Furthermore, Dr. Apaak highlighted the unacceptable reality of approximately 1 million pupils in Ghana having to sit on the floor to learn.

    “What that means is that about one million of our wards go to school every day and they have to sit on the floor or sit on blocks to study. That clearly cannot be acceptable.”

    He expressed confidence that his flagbearer, Former President John Dramani Mahama, would address furniture deficits in basic schools to tackle this issue effectively.

  • Sir Adjaye National Cathedral architect attacked by armed robbers in Ghana

    Sir Adjaye National Cathedral architect attacked by armed robbers in Ghana

    The businessman and architect behind the National Cathedral project, David Adjaye, has been robbed of valuables totaling $85,000 in Accra.

    The accused, Yahuza Osumanu, who faces 26 charges of robbery and money laundering at High Court Criminal Division 5, allegedly stole Mr. Adjaye’s possessions during one of his operations.

    According to the prosecution, on December 11, 2023, Yahuza held Mr. Adjaye at gunpoint in Ridge and took his Rolex watch and a Panerai watch valued at $70,000 and $15,000 respectively.

    “On the December 11, 2023, the Papa 51 police patrol team received information about a robbery incident at Ridge. On receipt of the information, the patrol team proceeded to the crime scene.”

    “When they arrived at the scene, they met the complainant, Margaret Alice Shaw, who informed them that she was lying on her bed when the, accused person entered her room, pointed a gun at her, and instructed her to hand over all her money and valuables to him.”

    “She told the police that the accused person ransacked her room and made away with a Rolex watch valued at USD$70,000, a Panerai watch valued at USD$15,000 belonging to her son-in-law, David Adjaye,” Prosecution team presents brief fact of the case.

    Additionally, the prosecution informed the court that Yahuza Osumanu successfully robbed the former Second Lady, Matilda Amissah-Arthur, of various currencies, including GH¢3,000, USD$2,200, and €50, along with a gold watch and necklace valued at GH¢20,000 and GH¢5,000 respectively.

    The accused also allegedly robbed two others at gunpoint of their valuables.

    Although he pleaded not guilty to all charges, the accused has been remanded by the court. The court has instructed the prosecution to file the complete set of their disclosures, and the case has been adjourned to May 2, 2024.

    He has been implicated in a string of residential robberies in areas including the Airport Residential Area, Cantonments, Tesano, and Ridge, all located in the Greater Accra Region.

  • Absence of National Cathedral in performance tracker biggest omission – Alex Segbefia asks

    Absence of National Cathedral in performance tracker biggest omission – Alex Segbefia asks

    Former Health Minister, Alex Segbefia, has raised concerns about the government’s failure to include the National Cathedral in the recently unveiled performance tracker.

    During a discussion on JoyNews’ PM Express, Mr. Segbefia criticized the document for its notable discrepancies and omissions, questioning its accuracy and transparency.

    While stressing the importance of accountability in governance, Mr. Segbefia emphasized the need for accuracy and transparency in such documents.

    “… Even on infrastructure, the biggest omission is the National Cathedral. Where is it? Government money has been invested into the national cathedral, so why is it not on the performance tracker?” he quizzed.

    The ex-Minister highlighted inconsistencies in the performance tracker, indicating a lack of thoroughness in its compilation.

    However, he attributed these discrepancies to negligence rather than deliberate oversight.

    “There are things there that should never have been there because they are non-existent. And there is the issue of projects that were not done by the government. They were done by NGOs, private companies, and alumni but they are in the performance tracker even though it didn’t cost the government a dime.

    “Then we have things the NPP sees as commendable but we think are just too petty. So if you give out jerseys or build a speed ramp, we don’t expect to see this. So when you look at them, you realise that the tracker sways towards more politics than governance,” he said on Monday.

    He condemned its omission of crucial indicators like the Press Freedom Index and the Corruption Index, which he considered vital for a comprehensive assessment of the nation’s performance.

    “It didn’t capture the Corruption Index even though it was a campaign tool the NPP used heavily when they were in opposition to get into power. If you are tracking, track everything that is happening in the country holistically. If it is just on infrastructure issues then let us know,” he said.

    In response to the Minister, Presidential Staffer Dennis Miracles Aboagye acknowledged the shortcomings of the tracker, stating that it is still a work in progress.

    He emphasized that all feedback is appreciated and will be addressed appropriately.

    “This is a tracker, which means it is a living document, it is updated by the minute, hour, and day. There is absolutely nothing wrong if he thinks there is something that should be in the tracker that isn’t, it can be considered.

    “We shouldn’t make it look like it is a big deal if someone identifies that the cathedral or something is not on the tracker. It can be worked on,” he stated.

  • National Cathedral: The trustees are supposed to raise funds to help complete the project – Abena Osei-Asare

    The Minister of State-Designate for Finance, Abena Osei-Asare, has emphasised the significance of the Board of Trustees involvement in fundraising to facilitate the project’s completion.

    While acknowledging the government’s contribution, she mentioned the importance of the trustees fulfilling their role in advancing the project.

    According to her, “the National Cathedral is also made up of trustees and these trustees are also supposed to, they are there to raise monies to help complete the project. The government has contributed its seed fund and I believe that now it is also up to the trustees to do their part to make sure we realise this dream.”

    has admitted that certain aspects of the management of the National Cathedral project could have been handled better.

    During her vetting on Wednesday, March 13, Mrs. Osei-Asare acknowledged that there were areas where improvements could have been implemented in overseeing the project.

    She emphasised the significance of the Board of Trustees in fundraising to facilitate the project’s completion. While acknowledging the government’s contribution, she emphasised the importance of the trustees fulfilling their role in advancing the project.

    “Mr. Chairman, I think we could have gone over it better than what we have done, that I must admit, because, for me, it’s a very personal issue because I’m a Christian.”.

    The National Cathedral project has faced significant public scrutiny, particularly regarding transparency concerns related to its financing and construction progress. Initially scheduled for commissioning on March 6, the project has attracted scrutiny, especially from minority MPs, who have raised concerns about its expenditure and the lack of transparency in fund allocation.

  • Handling of National Cathedral project not the best, could have been better – Abena Osei-Asare

    Handling of National Cathedral project not the best, could have been better – Abena Osei-Asare

    Abena Osei-Asare, the Minister of State-Designate for Finance, has acknowledged that there were areas in the management of the National Cathedral project that could have been handled more effectively.

    During her vetting on Wednesday, March 13, Mrs. Osei-Asare conceded that improvements could have been made in overseeing the project.

    She stressed the importance of the Board of Trustees in fundraising to support the project’s completion, noting that while the government has made its contribution, it’s now imperative for the trustees to fulfil their role in advancing the project.

    “Mr. Chairman, I think we could have gone over it better than what we have done, that I must admit because, for me, it’s a very personal issue because I’m a Christian.”

    “Mr Chairman, the National Cathedral is also made up of trustees and these trustees are also supposed to, they are there to raise monies to help complete the project. Government has contributed its seed fund and I believe that now is also up to the trustees to also do their part to make sure we realize this dream,” she said.

    The National Cathedral project has faced significant public criticism, particularly regarding transparency issues related to its financing and construction progress.

    Originally scheduled for commissioning on March 6, the National Cathedral has come under scrutiny, especially from minority MPs, who have raised concerns about its expenditure and the lack of transparency in fund allocation.

  • We need about US$250m more to complete the National Cathedral – Rev. Kusi Boateng

    We need about US$250m more to complete the National Cathedral – Rev. Kusi Boateng

    The Secretary to the Board of Trustees of the National Cathedral project, disclosed the anticipated funding requirement for the completion of the facility, which has encountered obstacles due to financial challenges, as reported by the project secretariat.

    During an interview on Onua FM on March 7, 2024, Kusi Boateng emphasized the importance of recognizing the national benefits upon completion, urging the faithful to contribute towards the estimated amount of US$200 million to US$250 million needed to finish the National Cathedral.

    “If we could raise an amount of US$200 million to US$250 million, the National Cathedral will be completed. Let’s look at the advantages the Cathedral will bring to Ghana and its financial benefits. As a nation, God has blessed us, we need to come together and thank Him,” Rev. Kusi Boateng stated.

    He highlighted the project’s comparative cost effectiveness and superior facilities compared to a similar endeavour in the United States.

    “Washington Museum in construction cost US$600 million but after the completion of the Cathedral, Ghana shall have a Bible museum of Africa that will in terms of space, content and technology be higher than the American Museum that cost them US$600 million.

    “If you look in-depth into the data, you realise that although US$300 million is money but compared to the US$600 million, we’ve done well,” he stressed.

    Kusi Boateng addressed concerns raised by MP Samuel Okudzeto Ablakwa, dismissing allegations of illegalities and corruption associated with the project.

    Ablakwa has been an outspoken advocate for accountability in the use of public resources for the cathedral, citing issues of corporate governance breaches, financial impropriety, and identity fraud within the Board of Trustees.

  • God is not petty; we do not need a million-dollar cathedral to please him – KSM

    God is not petty; we do not need a million-dollar cathedral to please him – KSM

    Ghanaian actor, director, satirist, talk show host, and author, Kwaku Sintim-Misa, popularly known as “KSM,” has voiced his concerns over what he deems as misplaced priorities by the New Patriotic Party (NPP) government.

    In his critique, KSM emphasized the importance of the government aligning its priorities correctly.

    Specifically addressing the National Cathedral project, he expressed his belief that such endeavours are unwarranted.

    KSM argued that the allocation of millions of dollars for the construction of a National Cathedral is a misstep, suggesting that there are more meaningful ways to honour God.

    According to him, God is not petty, and he stressed that funds could be better utilised for essential projects, such as building health facilities to save lives.

    “We’ve made God a petty God by thinking we can build a million-dollar cathedral to please him. There are far more important projects monies could be spent on to honour God like building a health facility to save mothers,” stated KSM.

    Watch video below:

  • GHS2.6m I loaned for National Cathedral project was refunded to me – Rev. Kusi Boateng

    GHS2.6m I loaned for National Cathedral project was refunded to me – Rev. Kusi Boateng

    The Executive Secretary of the Board of Trustees overseeing the National Cathedral Project, Rev. Victor Kusi Boateng, has denied accusations of illicitly receiving GH¢2.6 million from the initiative.

    The allegations were levied by the Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa.

    In an interview on Onua FM on March 7, 2024, Rev. Boateng refuted the claims, asserting that the GH¢2.6 million in question was actually a loan he provided to the project.

    The National Cathedral Project was facing financial challenges and urgently required funds for crucial purchases.

    Rev. Boateng emphasized that these transactions were well-documented in an official letter.

    In response to the accusations, Rev. Boateng expressed his disbelief, stating, “It’s so funny, human beings know the truth but will look upon the face of God and lie. How can a whole MP who come out to say that I have stolen GH¢2.6 million, if he does this, how can we build the Cathedral?”

    “The person doing this has seen the said documents, he’s seen it privately, he’s seen it publicly that the Cathedral had to make some payments for some items, and at the time the Cathedral didn’t have money to support itself.

    “As the Secretary, I informed the Secretariat that I had some money that I could help assist in making such payments, and with that, an official letter was written to me to release the funds that I said I had and after 14 days or so, the funds were transferred back to me ” Rev. Boateng explained.

    He further explained that as the Secretary, he informed the Secretariat about the available funds he could contribute to essential payments.

    An official letter was then drafted, requesting the release of the funds, and after approximately 14 days, the funds were returned to him.

    Another member of the Board of Trustees, Reverend Dr. Joyce Aryee, had earlier defended the GH¢2.6 million payment to JNS Talent Centre Limited, a firm connected to Kusi Boateng. She explained that the secretariat urgently needed the amount to settle a contractor but lacked the funds. In response, Rev. Victor Kusi Boateng stepped in to pay the specified amount, which was subsequently refunded to him without any interest.

  • Additional US$250m needed for National Cathedral completion – Board of Trustees Secretary

    Additional US$250m needed for National Cathedral completion – Board of Trustees Secretary

    A member and secretary to the Board of Trustees of the National Cathedral project, Rev. Victor Kusi Boateng, has provided an estimate of the funds required to complete the facility amidst reported funding challenges leading to project delays.

    In a March 7, 2024 interview on Onua FM, Kusi Boateng emphasized the importance of considering the advantages that the completed National Cathedral would bring to the nation.

    He stated, “If we could raise an amount of US$200 million to US$250 million, the National Cathedral will be completed. Let’s look at the advantages the Cathedral will bring to Ghana and its financial benefits. As a nation, God has blessed us, we need to come together and thank Him.”

    He added that comparatively, the project would be less expensive than a similar one in the United States, pointing out that Ghana’s edifice will also boast of more attractive facilities.

    Comparatively, he highlighted that the project’s cost would be less than a similar one in the United States while featuring more attractive facilities.

    Kusi Boateng pointed out, “Washington Museum in construction cost US$600 million but after the completion of the Cathedral, Ghana shall have a Bible museum of Africa that will in terms of space, content and technology be higher than the American Museum that cost them US$600 million.

    “All costs together our Cathedral, Biblical Museum, Biblical Gardens is just around $300 million, and ours is bigger than the American Bible Museum that costs $600 million.

    Furthermore, Kusi Boateng dismissed claims made by Member of Parliament Samuel Okudzeto Ablakwa, who has raised concerns about the project’s legality and alleged corruption.

    Ablakwa has been vocal about demanding accountability for the use of public resources in the cathedral project, citing issues related to corporate governance breaches, financial impropriety, and identity fraud within the project’s Board of Trustees.

    “If you look in-depth into the data, you realise that although US$300 million is money but compared to the US$600 million, we’ve done well,” he stressed

  • “2 Chronicles 6:7-9” – Akufo-Addo, the chosen one to build the National Cathedral – Gabby-Otchere

    “2 Chronicles 6:7-9” – Akufo-Addo, the chosen one to build the National Cathedral – Gabby-Otchere

    Ghanaian lawyer and stalwart of the New Patriotic Party (NPP), Gabby Otchere Darko, appears to have declared President Akufo-Addo as the appointed one to build the controversial National Cathedral project after tweeting a scripture on God choosing Solomon over David, his father, to build him a temple.

    His tweet comes after the opposition National Democratic Congress MPs, led by North Tongu MP Samuel Okudzeto Ablakwa, went to commission the uncompleted cathedral in mockery of the incumbent government to highlight its failure to finish the project.

    The Finance Minister, Ken-Ofori Atta, announced on the floor of Parliament that the National Cathedral project will be completed and commissioned on March 6, 2024, while delivering the 2021 mid-year budget review in Parliament on Thursday, July 29, 2021.

    Consequently, the lawyer tweeted on March 7, 2024, 2 Chronicles 6:7-9, which states that

    “My father David had it in his heart to build a temple for the Name of the Lord, the God of Israel. 8But the Lord said to my father David, ‘You did well to have it in your heart to build a temple for my Name. Nevertheless, you are not the one to build the temple, but your son, your own flesh and blood—he is the one who will build the temple for my Name.’

    Gabby Otchere-Darko has been a vocal advocate for the National Cathedral project.

    He contends that it represents a significant legacy for the nation and serves as a prominent symbol of Christianity on the African continent.

    In defending the project, Otchere-Darko rebuts criticisms suggesting it is a misuse of public funds and a breach of the secular constitution.

  • National Cathedral is a good idea – NDC’s Dafeamekpor

    National Cathedral is a good idea – NDC’s Dafeamekpor

    Ghana requires infrastructure similar to the National Cathedral, according to South Dayi MP Rockson Etse Dafeamekpor.

    He emphasised the absence of a central spiritual hub in the country and proposed that building a cathedral would be a beneficial endeavour.

    In an interview with JoyNews, Mr. Dafeamekpor expressed reservations regarding the project’s chosen site and financing, implying a lack of government dedication to its realisation.

    “It has always been my position that the idea is good, but the grievance people have is that, because we have moved into an economic meltdown, it is not necessary.

    “We should not be doing it at this hour, but it is something if we have it, and if we have the wherewithal to support it, it is good to have it.

    “Looking at the sums of money involved, we should have seen the structure up, even if it is not completed.”

    Despite former Finance Minister Ken Ofori-Atta’s assurance that the National Cathedral would be completed by March 6, 2024, construction progress remains limited to the foundation level.

    Members of Parliament from the National Democratic Congress, led by North Tongu MP Samuel Okudzeto Ablakwa, attempted a symbolic commissioning of the project.

    However, their efforts were met with opposition from security personnel, citing directives from higher authorities.

    Nevertheless, Mr. Ablakwa outlined several demands during the incident.

    “We are demanding full accountability for what happened to our $8,141,552. We are demanding that the board of trustees of the national cathedral be dissolved without delay.

    “We are calling on all the prosecutor institutions to immediately commence the prosecution of all those who have caused this gross financial loss to the state,” he said.

  • Quickly publish findings of investigations into National Cathedral project – Ablakwa to CHRAJ

    Quickly publish findings of investigations into National Cathedral project – Ablakwa to CHRAJ

    Member of Parliament for North Tongu, Samuel Okudzeto Ablakwa, has called on the Commission on Human Rights and Administrative Justice (CHRAJ) to swiftly publish the findings of its investigations into the National Cathedral project.

    Mr Ablakwa’s request comes amidst growing concerns over the handling of the project, particularly regarding transparency and accountability in its execution.

    Mr. Ablakwa in January 2023 petitioned CHRAJ under Article 218 of the 1992 Constitution to investigate an alleged transfer of GH¢2.6million cash from the National Cathedral Secretariat to JNS Talent Centre Limited, a company he said belongs to Rev. Kusi Boateng.

    He also alleged a conflict of interest and possession of multiple identities by Rev. Kusi Boateng.

    CHRAJ, in a letter signed by the Director of Anti-Corruption, Stephen Azantilow, acknowledged receipt of the petition on Wednesday, January 18.

    “I am directed to acknowledge receipt of your complaint on the above subject matter lodged with the Commission on the 16th of January 2023 and to inform you that it is receiving attention,” the statement read.

    It has been over a year and the Commission on Human Rights and Administrative Justice (CHRAJ) is yet to make public its findings on the subject matter.

    Presently, Samuel Okudzeto Ablakwa has called on President Akufo-Addo to immediately dissolve the Board of Trustees for the National Cathedral project.

    The current members on the Board include prominent religious figures such as Apostle Prof. Opoku Onyinah, former Chairman of the Church of Pentecost, and Most Rev. Charles Palmer Buckle, Metropolitan Archbishop of Accra.

    The MP also wants the National Cathedral Secretariat to be immediately closed after receiving GHS225,962,500.

    He wants “the Board of Trustees and the National Cathedral Secretariat account for all private donations so far received, particularly their infamous US operations.”

    “All those responsible for this gross financial loss to the state must be prosecuted with immediate effect,” he added.

    This comes after a confrontation between MPs and officials of the opposition National Democratic Congress (NDC) with Ghana Armed Forces personnel while attempting to access the National Cathedral site on March 6, 2024 over delay in its completion.

    The National Cathedral, a $100-million inter-denominational project, was scheduled for completion before the commissioning date, March 6, as stated by then-Finance Minister Ken Ofori-Atta during the 2021 mid-year budget review in Parliament.

    However, a heavy security presence surrounded the cathedral on Wednesday, leading to a clash with MPs near the new Electoral Commission head office. Both the Ghana Police Service and the military had set up barricades, restricting access to the cathedral site.

    Nonetheless, Samuel Okudzeto Ablakwa symbolically “commissioned” the uncompleted National Cathedral project, highlighting what he perceived as the government’s failure to finish the project.

    Following the ceremony, he presented a number of requests to the President with regards to the stalled project.

    Mr Ablakwa wants an explanation from President Akufo-Addo on why he failed to fulfill his promise to God, to Parliament and to the sovereign Ghanaian people — the promise to commission his US$450million (GHS5.7billion) “priority of priorities” cathedral.

    He is demanding full accountability on what happened to the US$58,141,509.52 (GHS740million) and “why all we see here is the world’s most expensive pit and why the contractors, RIBADE JV abandoned the project for lack of payment 2 years ago.”

    The others are as follows; A comprehensive report on how much it has cost the state to so far replace and compensate some owners of demolished properties, and how much is still outstanding considering that aggrieved demolished property owners such as Waterstone Realty have resorted to the courts. We note that the following properties were recklessly demolished on the orders of President Akufo-Addo: Bungalows for Judges, Judicial Training Institute, Passport Head Office, Scholarship Secretariat, Bungalows for CHRAJ, Waterstone Realty Luxury Apartment Complex, Headquarters of Comsys IT Firm and the Malian Ambassador’s Residence.

    Contract must be immediately terminated to avoid further financial loss to the state. According to the contract, Ghana will have to pay Extension of Time Claims, Standing Time Claims, Abortive & Re-Works Cost due to Main Contractor Suspension.

    Retrievals from the following persons: David Adjaye — US$19.6million (GHS250million) Cary Summers — US$6million (GHS76million) Rev. Victor Kusi Boateng/Kwabena Adu Gyamfi — GHS2.6million.

    Publication of the Deloitte audit which was promised on 24th January, 2023 — more than a year ago.

    Mr Ablakwa has entreated the NPP Caucus in Parliament to desist from sabotaging the impending Parliamentary Probe after a unanimous parliamentary resolution.

    “The NPP’s unpatriotic conduct by deliberately delaying the submission of names of their members to the Rt. Hon. Speaker for the committee to commence work is most condemnable,” he added.

    Mr Ablakwa has again made a clarion call for a national debate leading to a possible national consensus on what should happen to the “world’s most expensive pit moving forward.”

    “Some have suggested a specialist children’s hospital which Ghana currently lacks, we also note that recently the Secretary-General of the TUC, Dr Anthony Yaw Baah suggested the place be converted to a hospital,” he added.
